Indonesia - Gajah Baru development update 23 June 2010
Forward looking statements This presentation may contain forward-looking statements and information that both represents management's current expectations or beliefs concerning future events and are subject to known and unknown…
Gajah Baru project update Contents Natuna Sea Block A development overview Gajah Baru development Project Metrics Accomplishments and Key Achievements Key Dates and Overall Level 1 Schedule Execution highlights Project Graphics &…
Natuna A Block development plan Anoa / AGX Complex Gajah Puteri (future) Gajah Baru Hub Pelikan, Naga, Iguana & Bison (future) Domestic Gas Delivery Batam (GSA3&4) International Gas Delivery Singapore (GSA2) June…
Gajah Baru development overview June 2010 Page 4
EPCI summary and split in scope of work Engineer, Procure, Construct & Install (EPCI) Contract is a joint venture between Saipem* and SMOE Saipem responsible for: Engineering and procurement of materials and packaged equipment Load…
Project metrics Design Life 20 years for Facilities, 50 Years for Pipeline Integrated Float-over Deck design, minimal Hook-Up Fabrication Durations CPP Topsides = 18 months Living Quarters = 13 months Component Weight CPP Topsides…
Key schedule dates CONTRACTUAL MILESTONES FIRST GAS 01 Oct 2011 WHP Facility Mechanical Ready for Drilling Acceptance 01 Oct 2010 15 Sep 2011 4Q 3Q 4Q 2009 2010 2011 1Q 2Q 3Q 2Q 2Q Delivery of Install CPP Vessels Export…

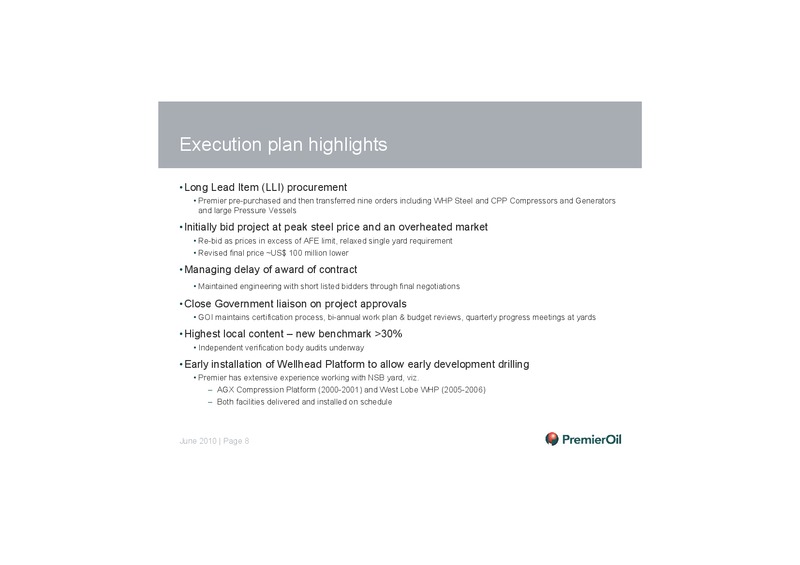

Execution plan highlights Long Lead Item (LLI) procurement Premier pre-purchased and then transferred nine orders including WHP Steel and CPP Compressors and Generators and large Pressure Vessels Initially bid project at peak steel…

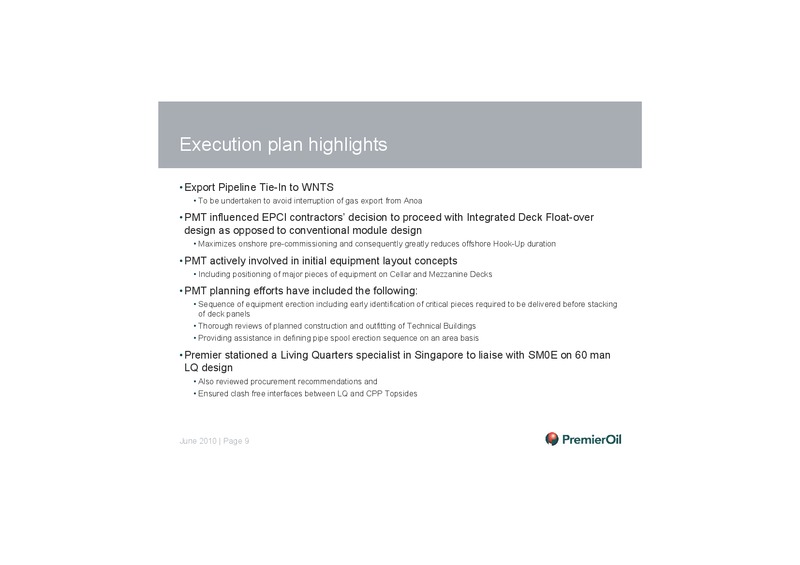

Execution plan highlights Export Pipeline Tie-In to WNTS To be undertaken to avoid interruption of gas export from Anoa PMT influenced EPCI contractors decision to proceed with Integrated Deck Float-over design as opposed to…
Wellhead platform (WHP) 3D CADD model Main Deck Cellar Deck Wellhead Control Panel Well Bay June 2010 Page 10
Wellhead platform (WHP) 3D CADD model Well Bay Area (Plan) Well Bay Area (Elevation looking South) June 2010 Page 11
Gajah Baru Central processing platform (CPP) CPP Topsides - 8,000 tonnes 3 x MAN Turbo Gas Compressors c/w Solar Turbine drivers (GTCs) Main Deck Flare Boom 2 x Solar Gas Turbine Generators (GTGs) Bridge to 60 man Living Quarters…
Gajah Baru Central processing platform (CPP) CPP Topsides 8,000 tonnes Cellar Deck frame and support columns Main Deck frame (to be stacked on Cellar Deck July 2010) June 2010 Page 14
Gajah Baru Central processing platform (CPP) CPP Jacket 4,800 tonnes Piles 1,200 tonnes June 2010 Page 15
Gajah Baru Central processing platform (CPP) 60 man living quarters June 2010 Page 16
Gajah Baru Central processing platform (CPP) 60 man living quarters (800 tonnes) June 2010 Page 17
Asian Hercules II heavy lift derrick barge Lifting Capacity: 3,200 tonnes June 2010 Page 18
West Callisto drill rig in Keppel FELS, Singapore June 2010 Page 19
Jack-Up rig drilling through wellhead platform June 2010 Page 20

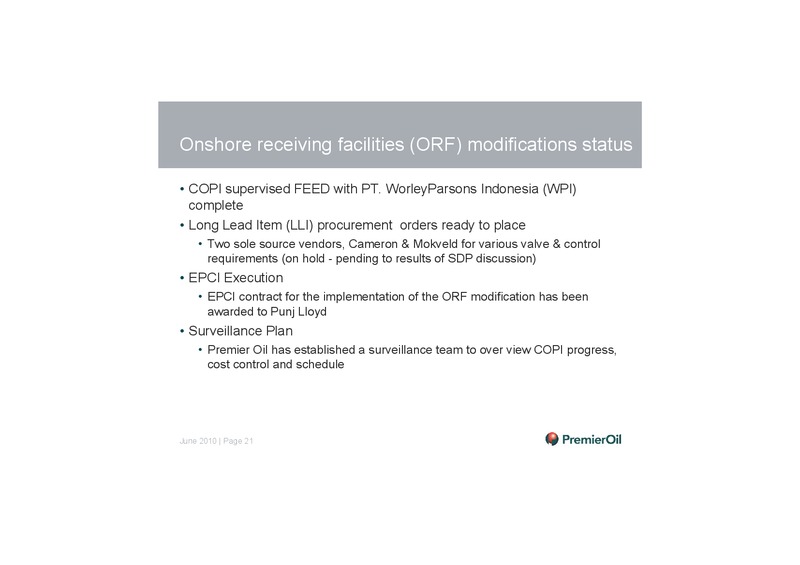

Onshore receiving facilities (ORF) modifications status COPI supervised FEED with PT. WorleyParsons Indonesia (WPI) complete Long Lead Item (LLI) procurement orders ready to place Two sole source vendors, Cameron & Mokveld for…
Incoming gas June 2010 Page 22
Overall ORF process facility June 2010 Page 23
Key events on Gajah Baru for 2H 2010 Engineering will reach 90% in August Procurement All WHP equipment & materials to be delivered by end of June Majority of CPP major equipment will be delivered by July/August Fabrication WHP…
