Agenda Background Exploration NW Moran Extended Production Test SE Mananda Development
Agenda Background Exploration NW Moran Extended Production Test SE Mananda Development
Exploration & Developments Background Oil production in PNG is declining Unless new production is brought on-line soon there is a risk that rapid unit operating cost increases will quickly force production shutdown Current projections…

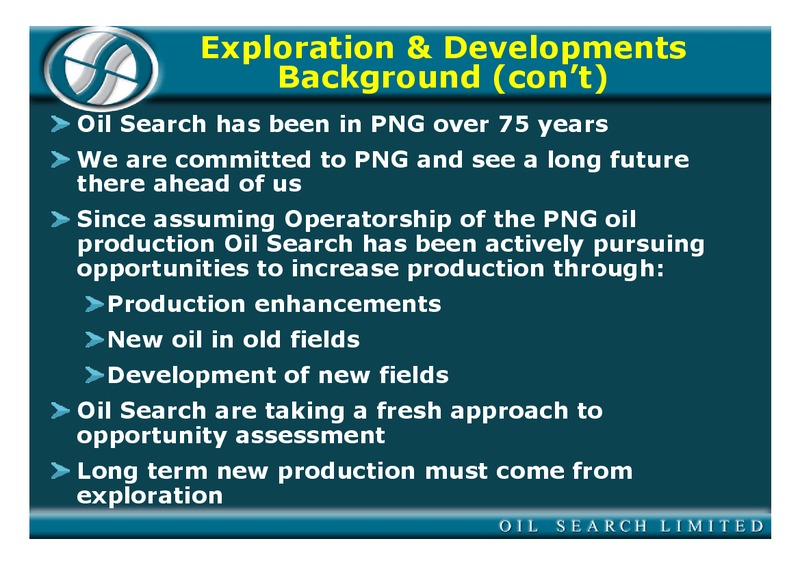

Exploration & Developments Background (cont) Oil Search has been in PNG over 75 years We are committed to PNG and see a long future there ahead of us Since assuming Operatorship of the PNG oil production Oil Search has been actively…
Exploration & Developments Current Status Exploration Active ongoing programme Firming up new drilling targets NW Moran Discovered in October 2003 Due on line 1Q 2005 at 3,000 Bbls/day SE Mananda Discovered in 1991 Historically…
Agenda Background Exploration NW Moran Extended Production Test SE Mananda Development
Oil Search Licence Status PPL219 PPL239 PPL190 PPL240 PPL244 PPL188
Recent Exploration Activity Drilling of NW Moran 1 in Aug-Oct 2003 Drilling of SE Moran 1 in Jan-Feb 2004 Completion of seismic program 1 (48km) in PPL219 and PDL2, August 2004 Site construction for Kapul 1 well, PPL240, Jan- April 2004…
NW Moran PPL219 commitment well Untested structure with possible separation from Moran field
2004 Seismic program 48km data in PPL219, PDL2 completed, data being processed and interpreted 70km data in PPL219, PPL190 underway Up to 300 personnel Key focus on HSES No LTIs
Seismic Phase 1 complete Define Mananda Attic drilling location Define Mananda Footwall lead Define Arakubi lead Infill information between Hedinia and Agogo Mananda Attic/FW Arakubi Compartment

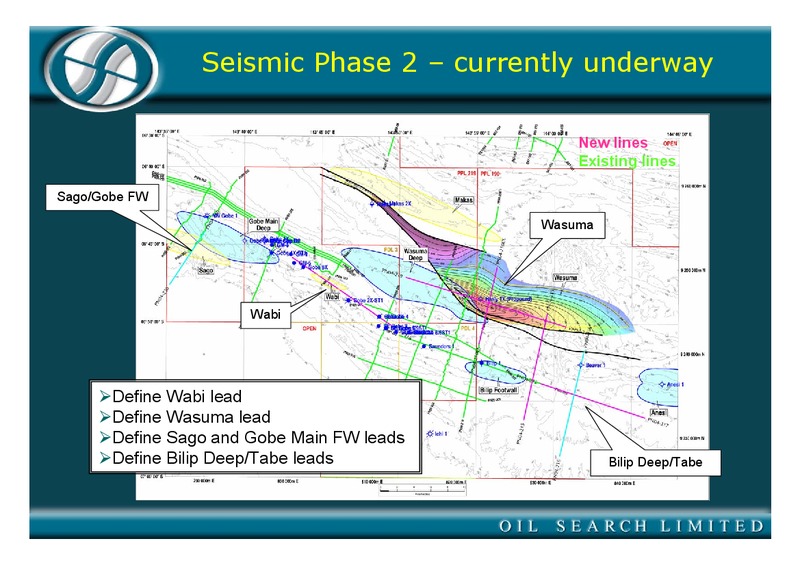

Seismic Phase 2 currently underway New lines Existing lines Sago/Gobe FW Wasuma Wabi Define Wabi lead Define Wasuma lead Define Sago and Gobe Main FW leads Define Bilip Deep/Tabe leads Bilip Deep/Tabe
Kapul well Important test of foreland oil potential Learning from Kimu and Koko wells Toro and Iagifu reservoir targets 100mmstb potential New play with follow up opportunities Rig move 90% Spud imminent Planned TD early January

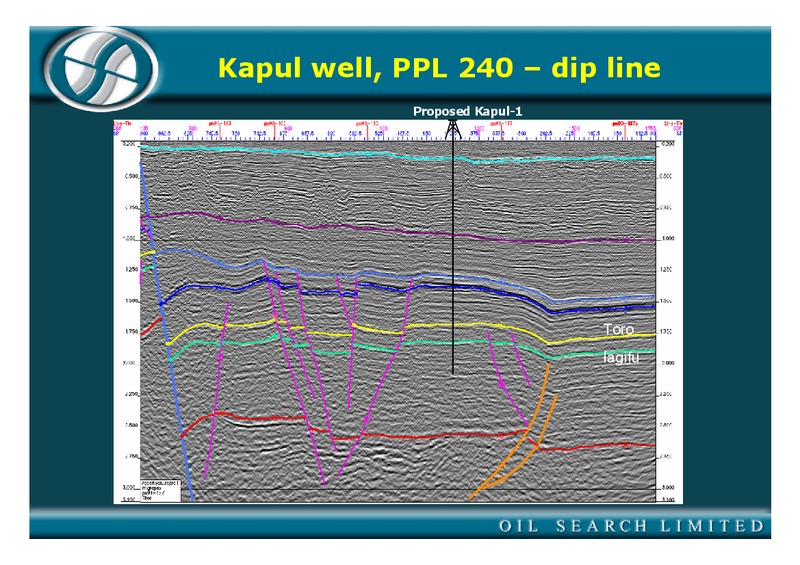

Kapul well, PPL 240 dip line Proposed Kapul-1 Toro Iagifu
Passive Seismic Pilot Study Passive seismic technique Using naturally-occurring (transmission) and induced (emission) microseismicity Has the potential: to develop a 3D model of subsurface velocity/structure to image active faults…
Forward exploration program PPL240 - Kapul 1 well TD in January Processing and interpretation of Mananda and Arakubi data ongoing feeding through to drilling schedule PPL219/PPL190/PDL4/SEG seismic program complete early January…
PPL 219, PDL 5 & Moran Unit Areas 1933 Moran Flow Line
NW Moran EPT Both Toro and Digimu are in communication with the Greater Moran Field, but there is some baffling Appraisal is being pursued by means of and Extended Production Test (EPT) to determine: Extent of baffling…
NW Moran EPT - Facilities Twin flowlines (production and gaslift) between NW Moran and Moran 4/6/9 bush run on H supports Production flowline from Moran 4/6/9 wellpad following road to the Agogo Production Facility (APF) New slug…
NW Moran EPT Current Status All required regulatory approvals are in place A Heads of Agreement with the local community supporting the work is in place Field construction is underway First oil due in 1Q 2005 This outcome will mean a…
Agenda Background Exploration NW Moran Extended Production Test SE Mananda Development
SE Mananda Locality MANANDA HEGIGIO ATTIC GORGE MANANDA NW MORAN FOOTWALL SE MANANDA MORAN SE MANANDA PROPOSED PIPELINE AGOGO CPF MORAN PIPELINE KUTUBU CPF

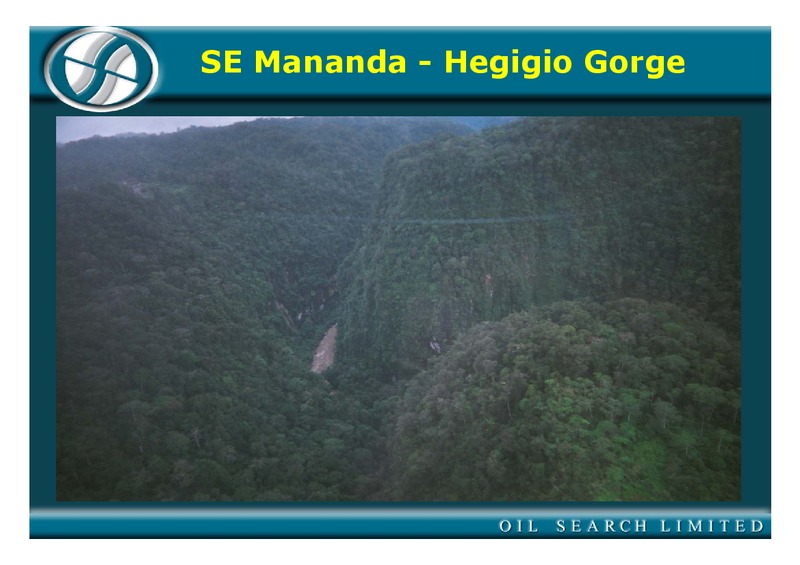

SE Mananda - Hegigio Gorge
SE Mananda Top Toro Most Likely Depth Map

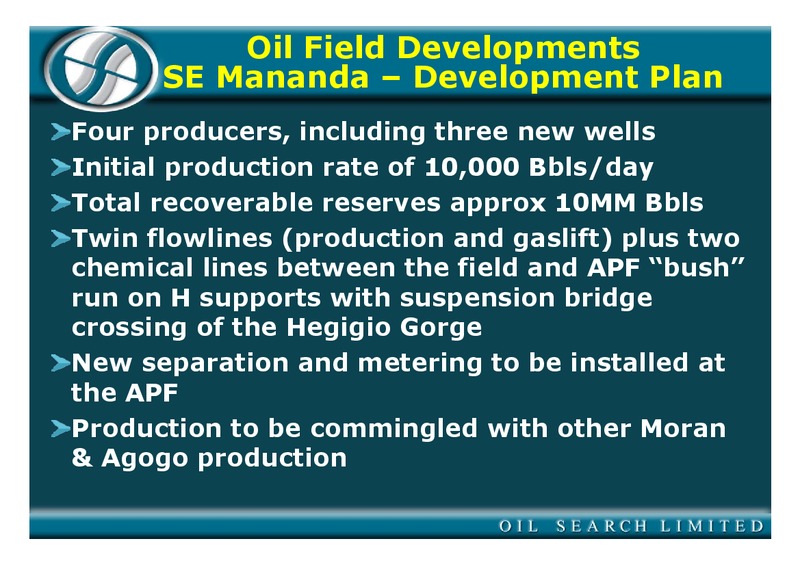

Oil Field Developments SE Mananda Development Plan Four producers, including three new wells Initial production rate of 10,000 Bbls/day Total recoverable reserves approx 10MM Bbls Twin flowlines (production and gaslift) plus two…
SE Mananda Drilling Plan Top TORO C intersection
SE Mananda - Hegigio Bridge ADD 1 the lookout North Abutment 470m
SE Mananda - Hegigio Bridge
SE Mananda Commercial Issues The field has stood undeveloped for 13 years because the low reserves and technically complex development make the economics marginal The JV has been working constructively with the State to develop…
SE Mananda Current Status Regulatory approvals are close to finalisation A Heads of Agreement with the local community supporting the work is in place Design work is well advanced All main materials and equipment have been ordered…
Explorations & Developments Conclusions New production is vital to sustaining the industry and the economy NW Moran and SE Mananda offer near a term boost in production that will greatly assist maintaining the vibrancy of the industry…
