JUNE 2011 CORPORATE PRESENTATION – Altagas Limited

Altagas Limited · Jun 22, 2011 · 38 slides

Investor presentation from the Shale Experts oil & gas presentation and slide database. Every page is imaged and its text indexed for search across operators, plays, basins and time.

Slides

  1. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 1
    AltaGas Ltd. Delivering superior returns Wednesday June 22, 2011
  2. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 2
    Forward-looking information Certain information presented today may constitute forward- looking statements with respect to AltaGas Ltd. Such statements reflect the Companys current expectations, estimates, projections and assumptions.…
  3. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 3
    AltaGas Ltd. (TSX:ALA) Diversified energy Financial strength infrastructure BBB (stable) credit rating Enterprise value 3 billion Bank liquidity of 975 million Natural gas gathering and Debt-to-total capitalization 43 processing…
  4. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 4
    Were a leading energy infrastructure company Gas Asset Base Growth 1.6 Bcf/d interests in six extraction 120 Mmcf/d Gordondale gas plant under facilities development 1.2 Bcf/d gas processing 250 Mmcf/d Harmattan Co-stream project…
  5. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 5
    2 billion of organic growth 5
  6. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 6

    Significant progress on capital growth plans Objective: 2 billion in organic growth (2010-2016) 2010 progress report: Approximately 1.4 billion in committed growth capital secured (includes 2010 - 200 million) Awaiting regulatory…
  7. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 7
    2010 Accomplishments Significant progress on executing our growth strategy Strong access to capital markets Our Growth Projects Business What Weve Accomplished This Year 60-yr EPA with BC Hydro and IBA signed with First Nations in…
  8. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 8
    Gas business growth focus Grow processing facilities to meet growing unconventional gas supply in Western Alberta and Northeast BC Source: Ziff Energy Group 8
  9. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 9
    Gordondale processing facility 120 Mmcf/d deep cut Encana processing agreement committing long-term supply Capital cost estimate: 235 million Phase I: 15 Mmcf/d processed by mid-2011 Phase II in-service: late-2012 Clearing…
  10. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 10
    The Montney is a good place to be - Gordondale 10
  11. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 11
    Younger extraction plant Licensed capacity 750 Mmcf/d Only fractionation plant in BC Owned 57 percent and operated by AltaGas Rail, truck and pipeline interconnectivity 30 percent interest in 250 Mmcf/d pipeline project to bring…
  12. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 12
    Abundant gas supply in Younger area 12
  13. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 13
    Optimizing assets - Harmattan Co-stream 250 Mmcf/d, 100 km pipeline increases throughput to near full capacity of 490 Mmcf/d Deep cut facility maximizes producer net-backs Positioned as a regional hub; rail, truck and pipeline…
  14. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 14
    Power business growth focus Harmattan Cogeneration II 15 MW gas-fired cogeneration In-service estimate: Q2 2012 Capital cost estimate: 24 million Sparwood waste heat recovery In-service estimate: Q1 2012 6 MW project, EPA with BC…

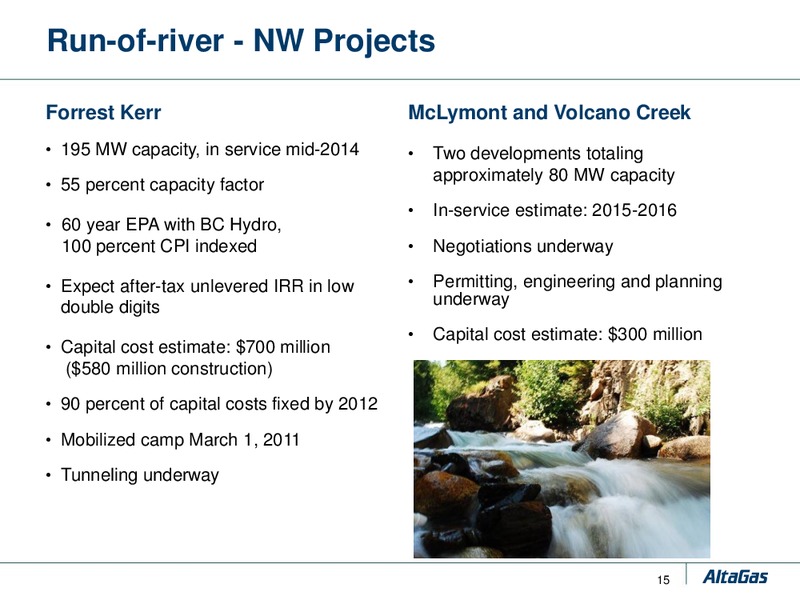

  15. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 15
    Run-of-river - NW Projects Forrest Kerr McLymont and Volcano Creek 195 MW capacity, in service mid-2014 Two developments totaling approximately 80 MW capacity 55 percent capacity factor In-service estimate: 2015-2016 60 year EPA…
  16. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 16
    Predictable, sustainable hydrological data 900 800 700 600 Discharge (m/s) Water flow used for generation 500 400 300 200 Design discharge of 252 m/s 100 Minimum release of 10 m/s 0 Jan Feb Mar Apr May…
  17. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 17
    Construction activities - Tunneling 17
  18. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 18

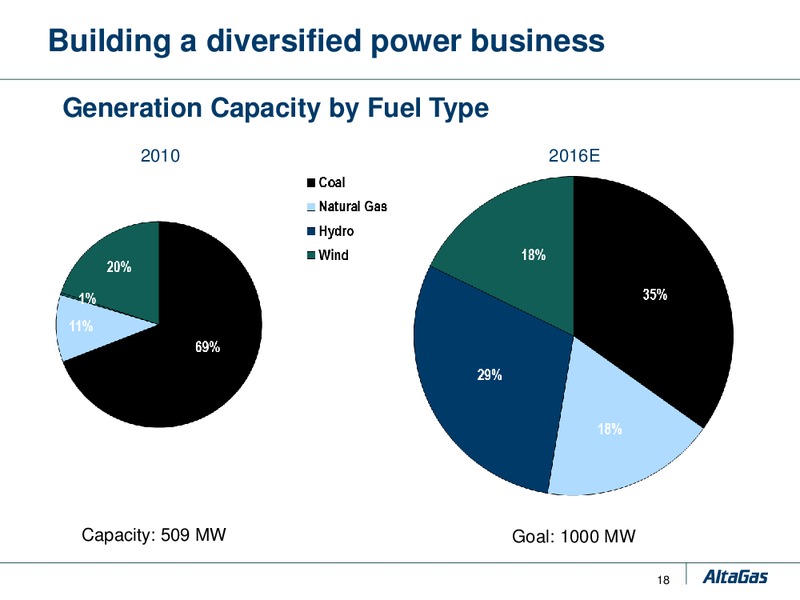

    Building a diversified power business Generation Capacity by Fuel Type 2010 2016E Capacity: 509 MW Goal: 1000 MW 18
  19. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 19
    Utility business growth focus 286 million 2010 rate base Rate base growth will drive earnings growth AUI 16 percent rate base growth in 2011 Heritage 25 percent rate base growth in 2011 Driven primarily by: Expansion of…
  20. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 20
    Growing and diversifying EBITDA Growing earnings Adding highly contracted, 6% 13% long-life infrastructure Unhedged Commodity Enhancing earnings stability 21% Hedged Commodity 16% 27% Fee for Service 22% Renewable Long…
  21. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 21

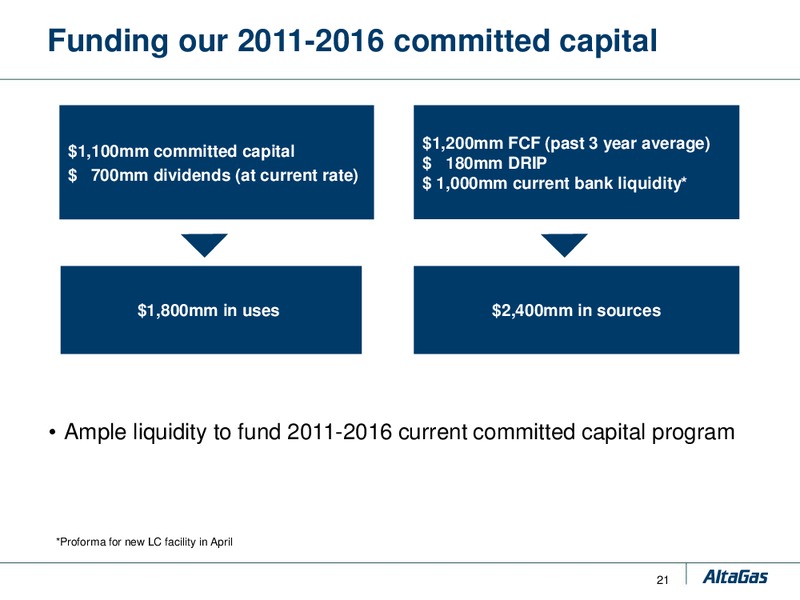

    Funding our 2011-2016 committed capital 1,100mm committed capital 1,200mm FCF (past 3 year average) 180mm DRIP 700mm dividends (at current rate) 1,000mm current bank liquidity* 1,800mm in uses 2,400mm in sources Ample…
  22. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 22
    Financial discipline Strong balance sheet Balanced debt maturity profile 22
  23. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 23
    Stable cash flow and earnings EBITDA: 244 million Operating income: 152 million Funds from operations: 195 million Net income: 97 million Normalized FFO payout: 56% Net income per share: 1.19 Dividend: 1.32 *TTM ending March…
  24. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 24
    Looking forward 2011 2012 Stronger results from all Projects in service: businesses Co-stream Gordondale Phase I Cogen II complete Waste heat recovery Younger pipeline complete Gordondale Higher deferred taxes (non- cash…
  25. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 25

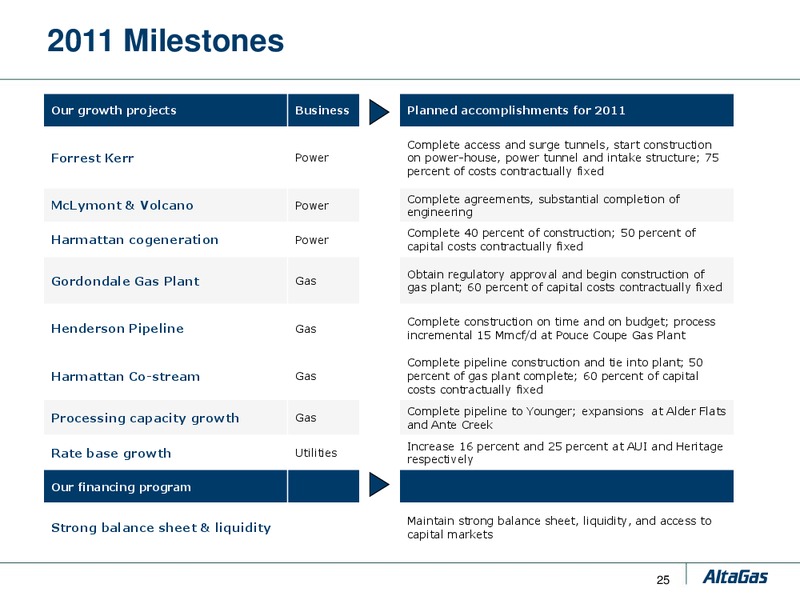

    2011 Milestones Our growth projects Business Planned accomplishments for 2011 Complete access and surge tunnels, start construction Forrest Kerr Power on power-house, power tunnel and intake structure; 75 percent of costs…
  26. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 26
    AltaGas is a good place to be Strong, diversified asset base of gas, power Attractive portfolio of and utilities energy infrastructure Capital growth focused on stable, long-term contracted projects and regulated asset growth assets…
  27. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 27
    Forrest Kerr construction site 27
  28. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 28

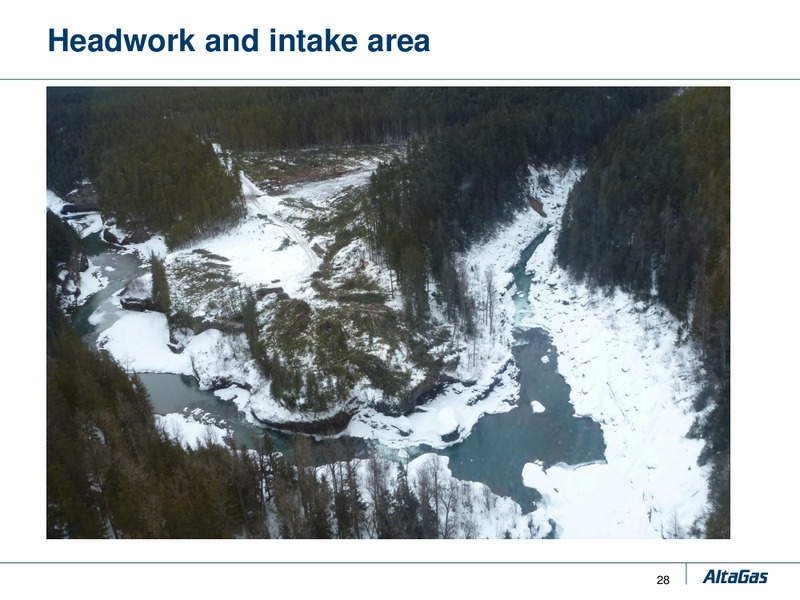

    Headwork and intake area 28

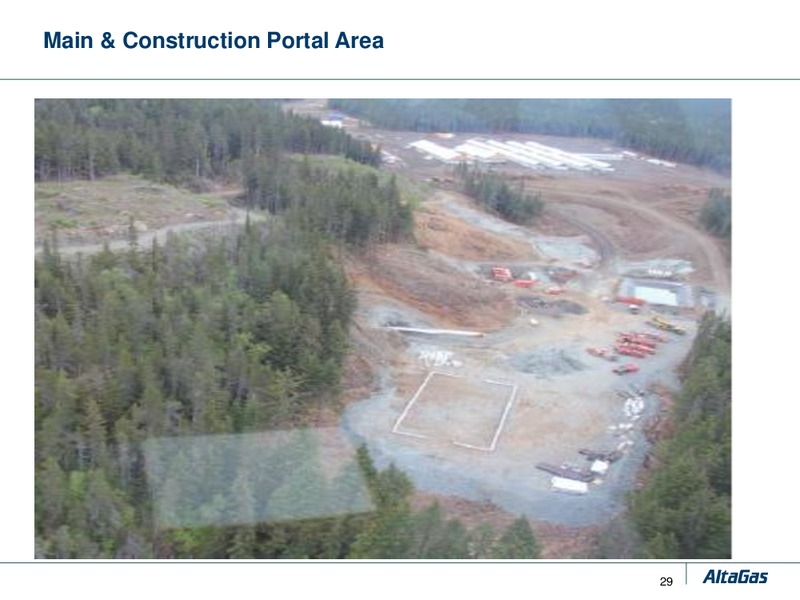

  29. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 29
    Main & Construction Portal Area 29 29
  30. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 30
    Intake Area 30
  31. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 31
    Power Tunnel Construction Access 31

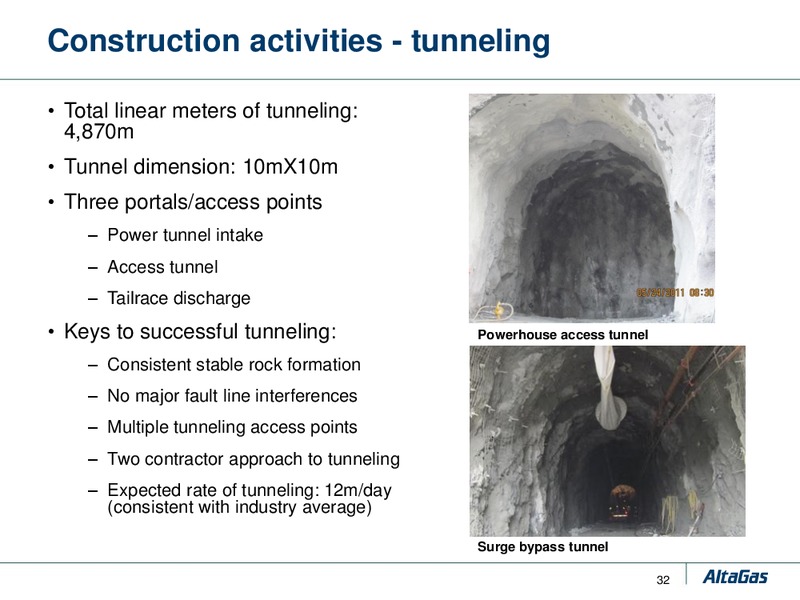

  32. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 32
    Construction activities - tunneling Total linear meters of tunneling: 4,870m Tunnel dimension: 10mX10m Three portals/access points Power tunnel intake Access tunnel Tailrace discharge Keys to successful tunneling: Powerhouse…
  33. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 33
    Excavation Map and Progress (May 31st) 33
  34. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 34

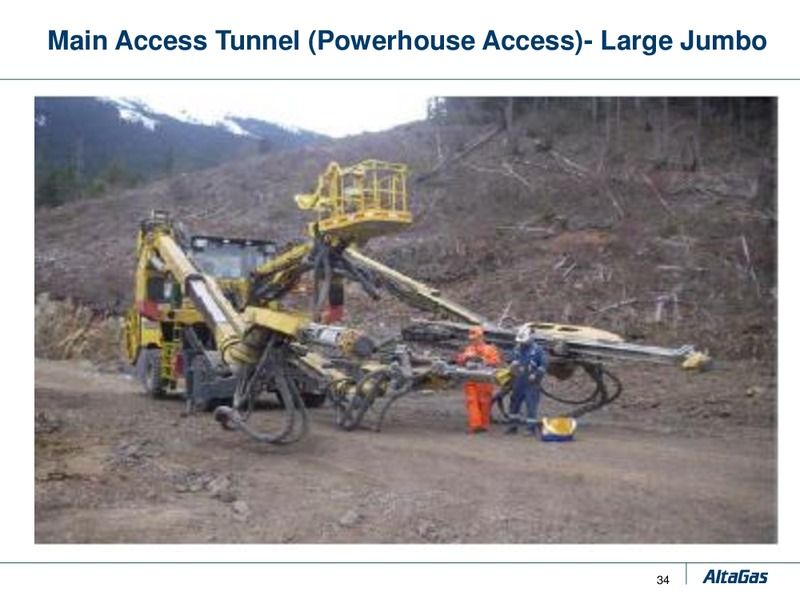

    Main Access Tunnel (Powerhouse Access)- Large Jumbo 34

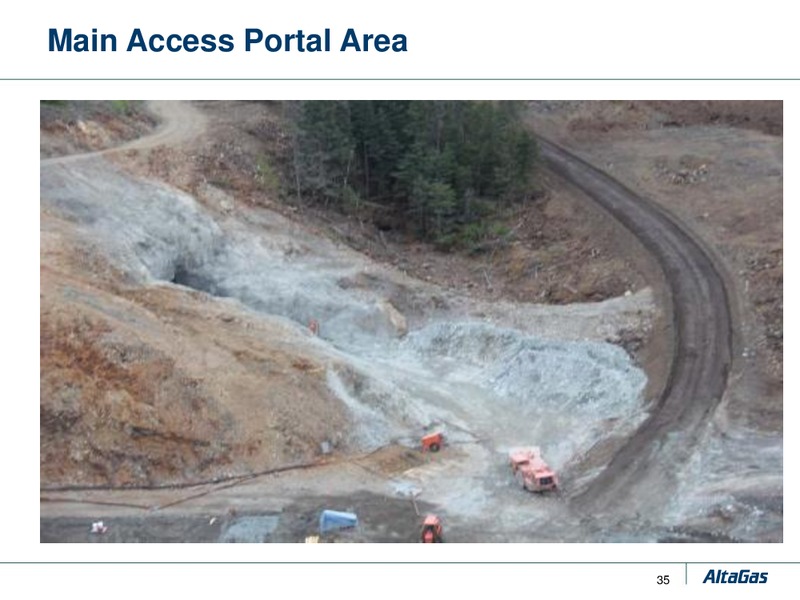

  35. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 35
    Main Access Portal Area 35
  36. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 36

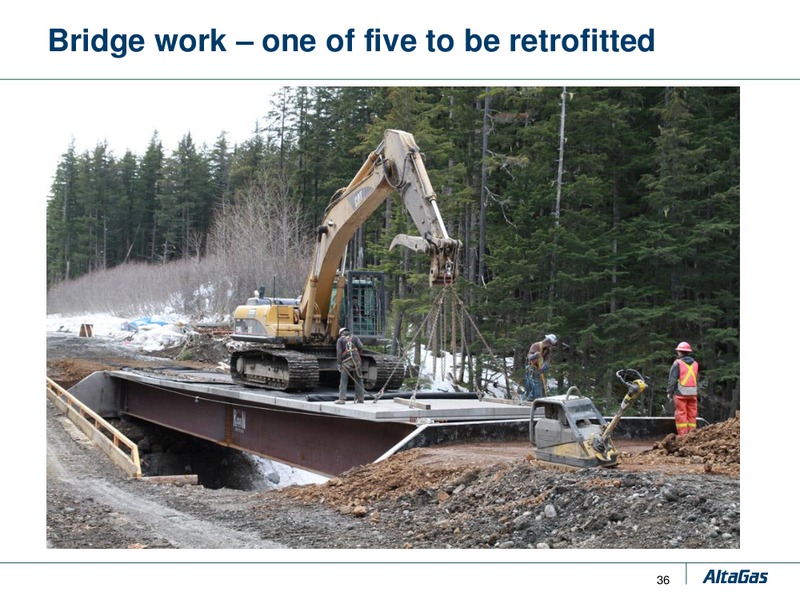

    Bridge work one of five to be retrofitted 36
  37. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 37

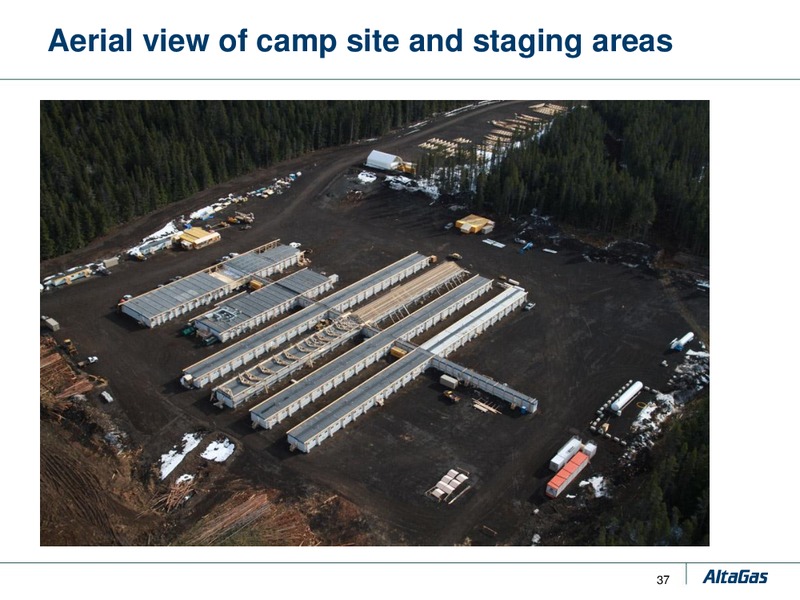

    Aerial view of camp site and staging areas 37

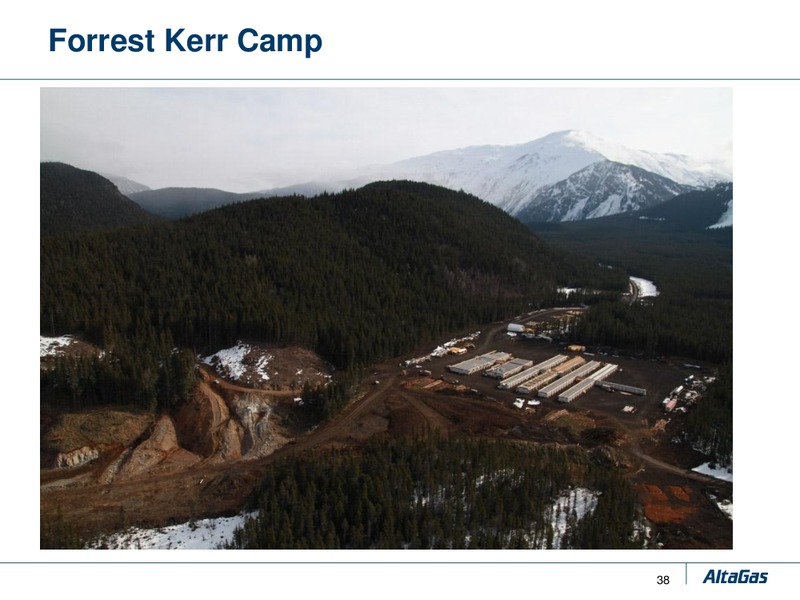

  38. JUNE 2011 CORPORATE PRESENTATION – Altagas Limited – slide 38
    Forrest Kerr Camp 38
