Madagascar Oil Limited Tsimiroro Discovered Field in Block 3104 3104 and 3102 Block Summaries Block 3104 - Tsimiroro Concession Operator: Madagascar Oil 100% Area: 6666.88 sq Km Bemolanga Block 3102 - Bemolanga Concession…
Madagascar Oil Limited Block Tsimiroro Field History Timeline Tsimiroro Field history - a +100 Year Timeline 5
Madagascar Oil Limited Block 3104 Tsimiroro Tsimiroro Block 3104 The Tsimiroro Field is a giant heavy oil reservoir 60 Km North South, 5-10 Km East West Stock Tank Oil Originally In Place Netherland Sewell 2011 Contingent Resources…
Tsimiroro Steam Flood Pilot Year to Date 2013 Performance
Madagascar Oil Limited Block 3104 Tsimiroro Steam Flood Pilot The Tsimiroro Steam Flood Pilot Conceived after 2008 CSS Huff and Puff success Designed as a test of the thermal recovery method successfully applied in California,…

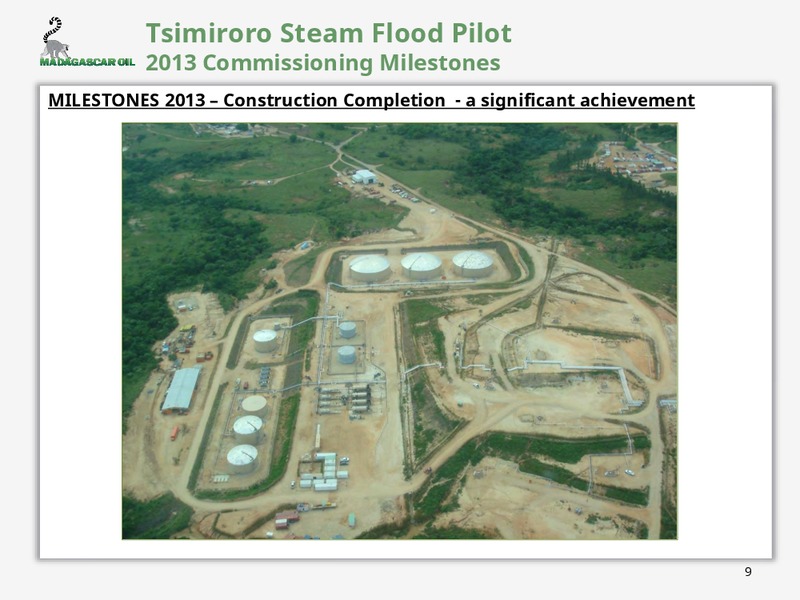

Tsimiroro Steam Flood Pilot 2013 Commissioning Milestones MILESTONES 2013 Construction Completion - a significant achievement 9
Tsimiroro Steam Flood Pilot 2013 Commissioning Milestones Steam Generation and Distribution Facilities 10
Tsimiroro Steam Flood Pilot 2013 Commissioning Milestones Production, Separation and Oil Storage Facilities 11

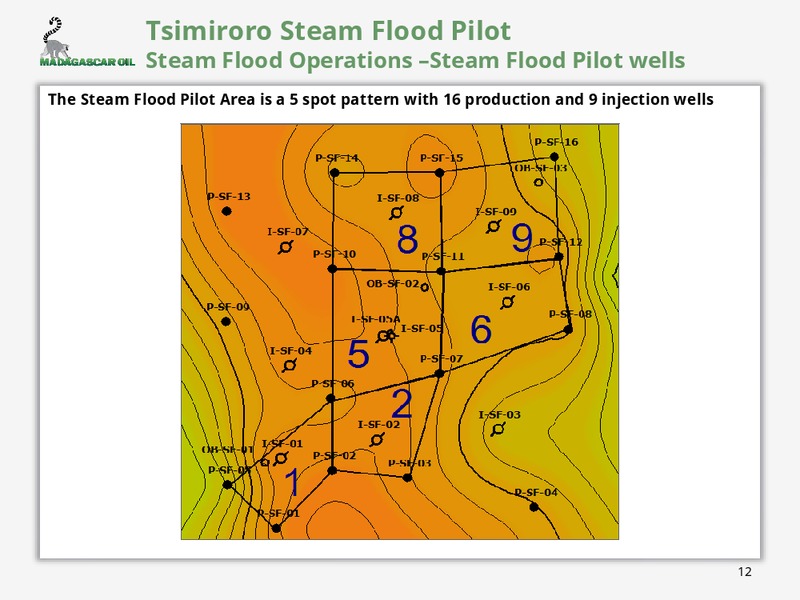

Tsimiroro Steam Flood Pilot Steam Flood Operations Steam Flood Pilot wells The Steam Flood Pilot Area is a 5 spot pattern with 16 production and 9 injection wells 12

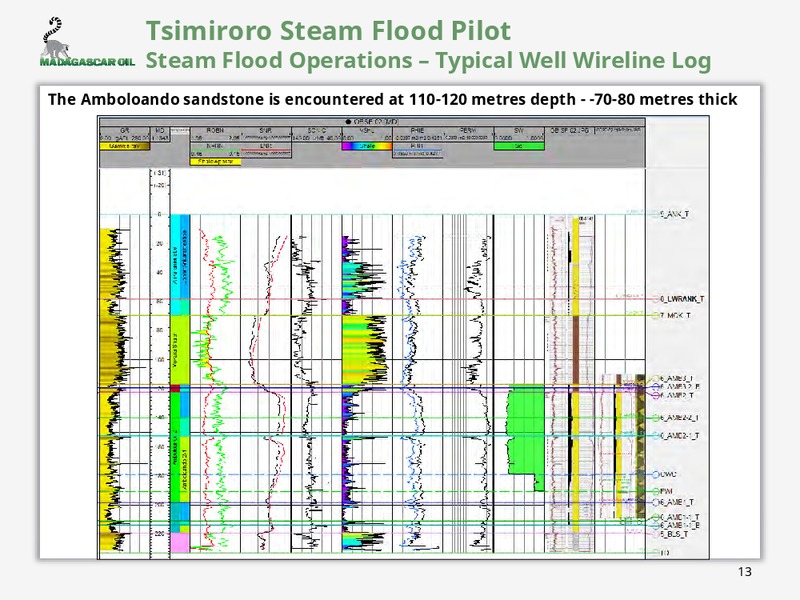

Tsimiroro Steam Flood Pilot Steam Flood Operations Typical Well Wireline Log The Amboloando sandstone is encountered at 110-120 metres depth - -70-80 metres thick 13

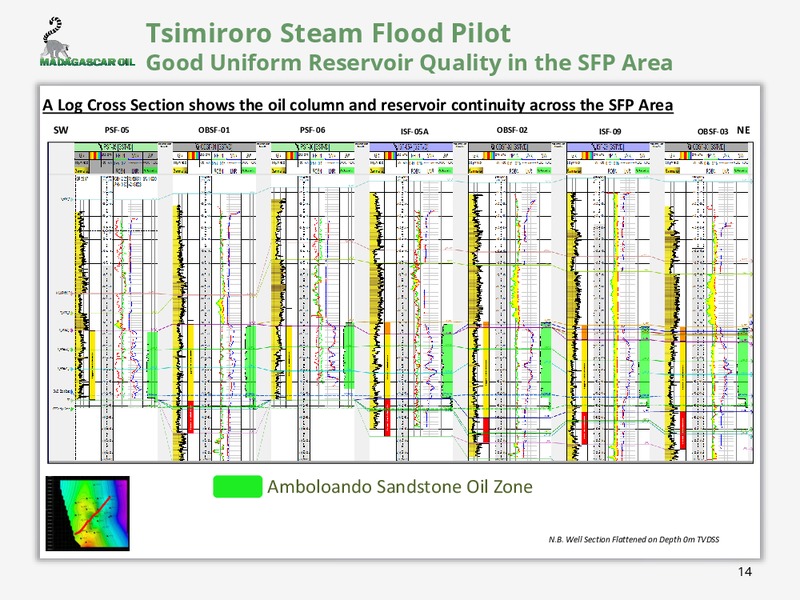

Tsimiroro Steam Flood Pilot Good Uniform Reservoir Quality in the SFP Area A Log Cross Section shows the oil column and reservoir continuity across the SFP Area SW PSF-05 OBSF-01 PSF-06 ISF-05A OBSF-02 ISF-09 OBSF-03 NE Amboloando…
Tsimiroro Steam Flood Pilot Steam Flood Operations - Steam Injection Profile Tsimororo Steam Flood Pilot Steam Injection Performance April to November 2013 2,000 Steam Injection Rates have built up to 1400 BWEPD 1,500 Steam…
Tsimiroro Steam Flood Pilot Steam Flood Operations Oil Production Profile Tsimororo Steam Flood Pilot Oil Production Performance April to November 2013 400 Oil Production Rates have built up to 200 - 300 BOPD 300 Oil…
Tsimiroro Steam Flood Pilot CSS (Huff and Puff) Operations Initial wells are into their 4th Huff and Puff Cycle eg PSF-3 Tsimororo Steam Flood Pilot - Well Perfomance PSF-3 April to November 2013 300 Injection Production Injection…
Tsimiroro Steam Flood Pilot Temperature Observation Well Monitoring Temperature Observation wells allow tracking of the thermal response Temperature [C] 27.7 32.7 37.7 42.7 0 Temperature Observation Well OBS-01 Response…
Tsimiroro Steam Flood Pilot Tsimiroro Crude Oil Tsimiroro Oil - sweet, heavy crude Tsimiroro Crude API 15 Low Sulphur 19
Tsimiroro Steam Flood Pilot Steam Flood Pilot Crew Tsimiroro Steam Flood Pilot crew celebrating 2 million manhours without a LTI 20
Madagascar Oil Community Projects Working with local villages to provide health, education and sanitation improvements Health Clinic Handover in Ankisatra Water well completion in Beravina Income Generation Nursery Plantation…
Tsimiroro Full Field Development Plan
Tsimiroro Development Planning Development Plan - Document The Development Plan will integrate all threads of technical, commercial and non-technical (Stakeholder) issues Geological & Geophysical Reservoir Exploration Drilling…
Tsimiroro Development Planning Tsimiroro Field Development Phases Proposed phased Field Development Plan Steam Flood Pilot Phase 1 Phase 2 Phase 3, 4, 5 The phases will encompass ever larger areas of the field and will include…
Tsimiroro Development Planning Notional Phased Development Phases - Key Characteristics Steam Flood Phase 1 Phase 2 Phases 3, 4, 5 Pilot STOOIP 3 MMb 50-100 MMb 300-500 MMb 1,700 MMb Recovery Cyclic to Steam Cyclic to Steam Flood…
Tsimiroro Development Planning Phase 1 Development Processing Facility The Steam Flood Pilot Facilities can be used during the Phase 1 Development 26

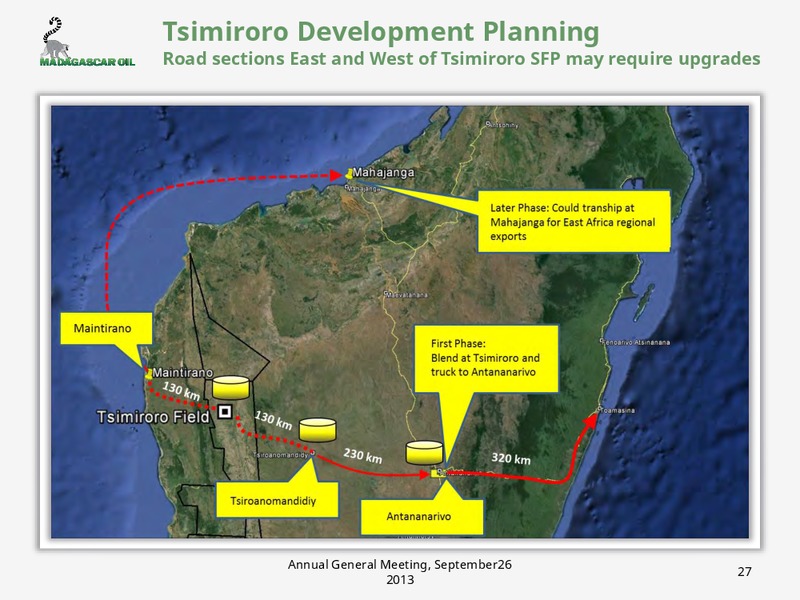

Tsimiroro Development Planning Road sections East and West of Tsimiroro SFP may require upgrades Annual General Meeting, September26 27 2013
Tsimiroro Field Development Planning Phase One Markets Local & International Annual General Meeting, September26 28 2013
