Madagascar Oil Limited Management Update 14 May 2012 Not for release, publication or distribution, directly or indirectly, in or into the United States, Canada, Australia or Japan. 14 May 2012 Investor Update 1
Contents Background and Overview Tsimiroro Heavy Oil Project Tsimiroro Economics Conventional Opportunities Funding and Capitalisation Appendix 14 May 2012 Investor Update 3
Background and Overview 14 May 2012 Investor Update 4

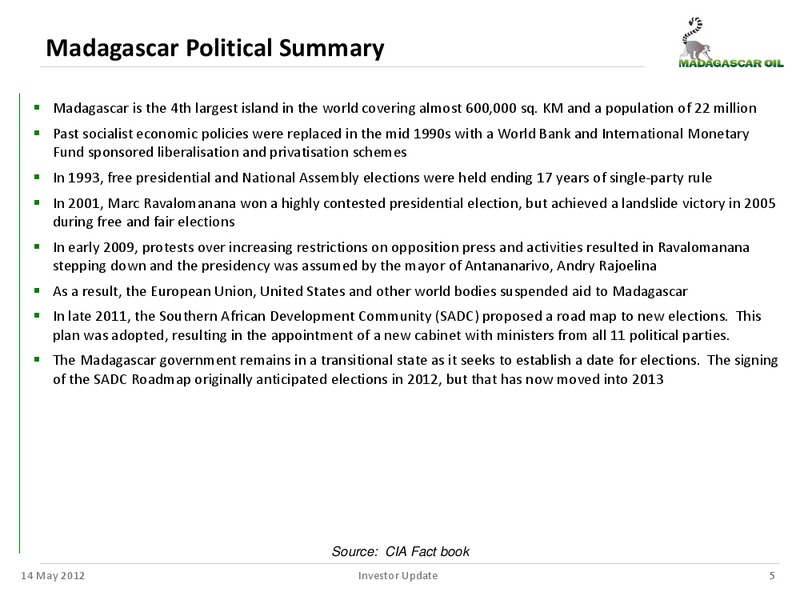

Madagascar Political Summary Madagascar is the 4th largest island in the world covering almost 600,000 sq. KM and a population of 22 million Past socialist economic policies were replaced in the mid 1990s with a World Bank and…

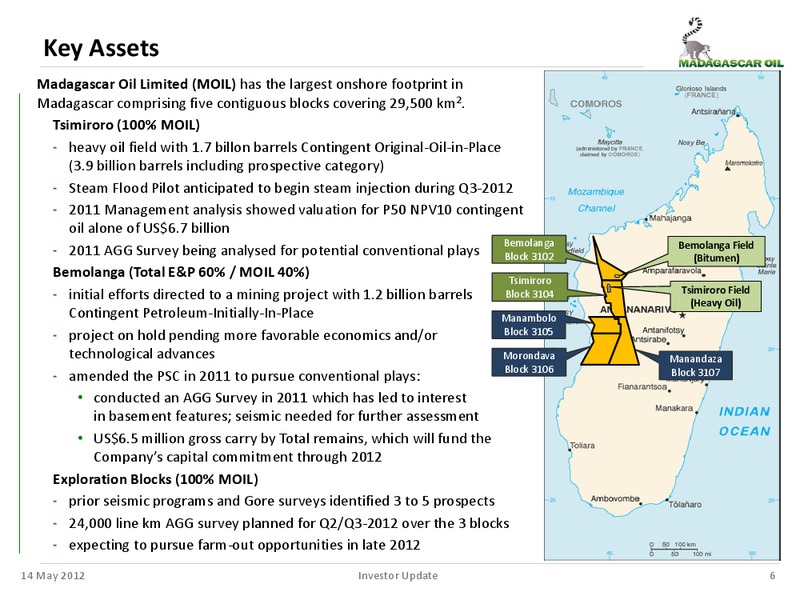

Key Assets Madagascar Oil Limited (MOIL) has the largest onshore footprint in Madagascar comprising five contiguous blocks covering 29,500 km2. Tsimiroro (100% MOIL) - heavy oil field with 1.7 billon barrels Contingent…

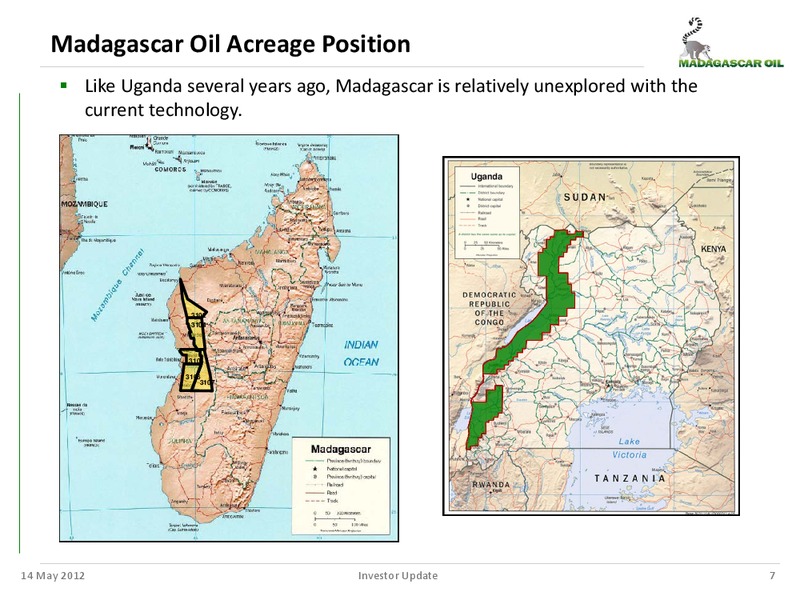

Madagascar Oil Acreage Position Like Uganda several years ago, Madagascar is relatively unexplored with the current technology. 3102 3104 3105 3106 3107 14 May 2012 Investor Update 7

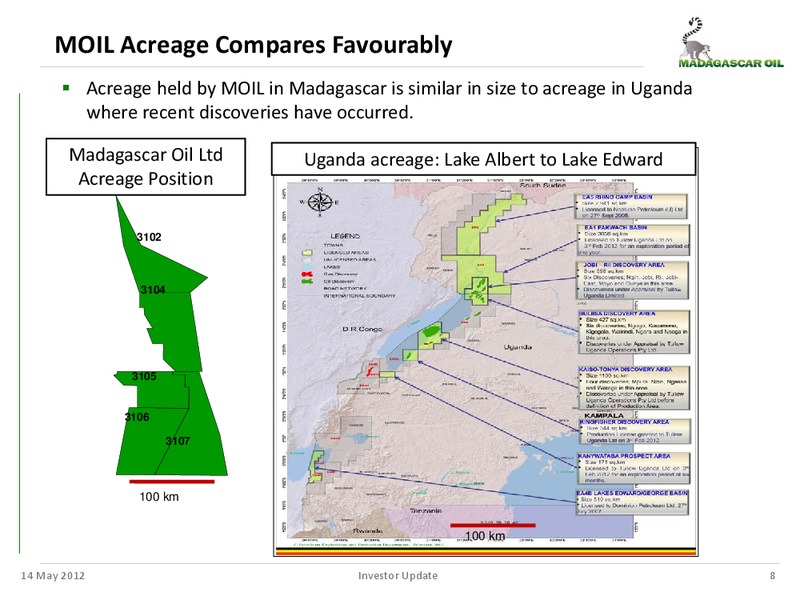

MOIL Acreage Compares Favourably Acreage held by MOIL in Madagascar is similar in size to acreage in Uganda where recent discoveries have occurred. Madagascar Oil Ltd Uganda acreage: Lake Albert to Lake Edward Acreage Position…

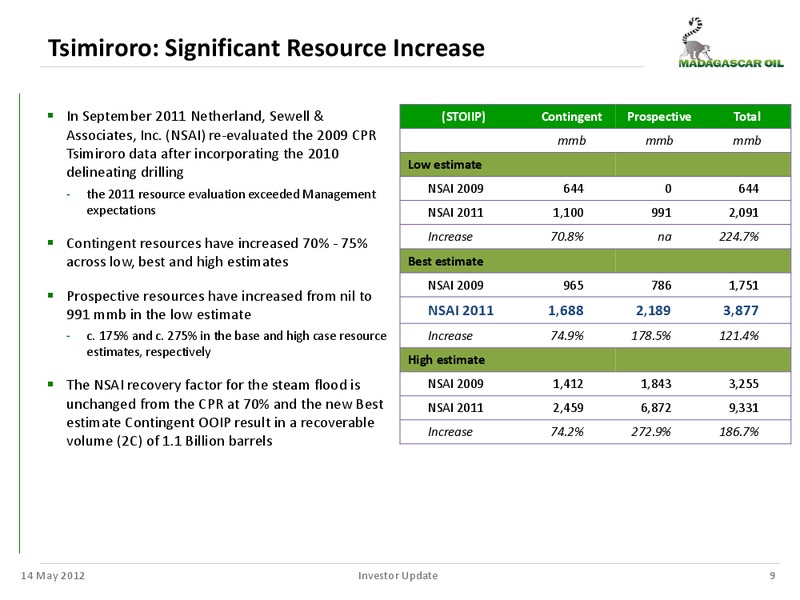

Tsimiroro: Significant Resource Increase In September 2011 Netherland, Sewell & (STOIIP) Contingent Prospective Total Associates, Inc. (NSAI) re-evaluated the 2009 CPR mmb mmb mmb Tsimiroro data after incorporating the 2010 Low…

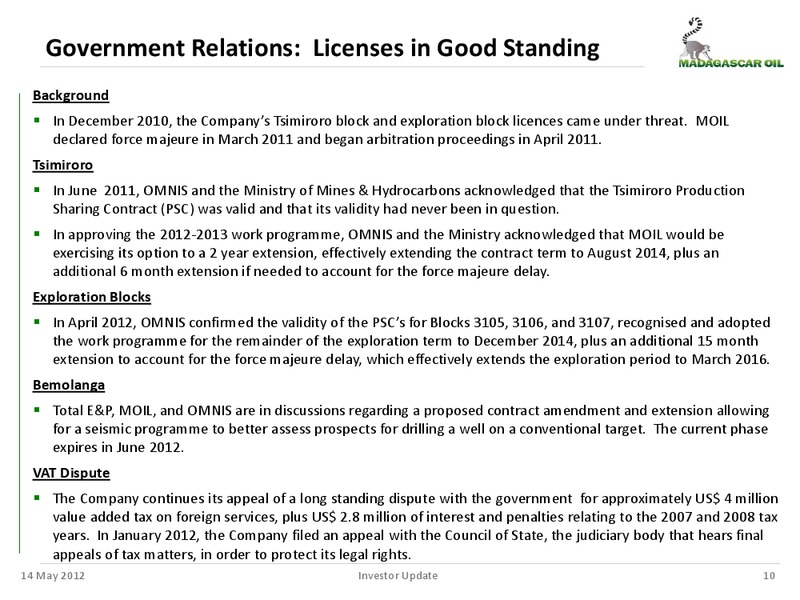

Government Relations: Licenses in Good Standing Background In December 2010, the Companys Tsimiroro block and exploration block licences came under threat. MOIL declared force majeure in March 2011 and began arbitration proceedings in…

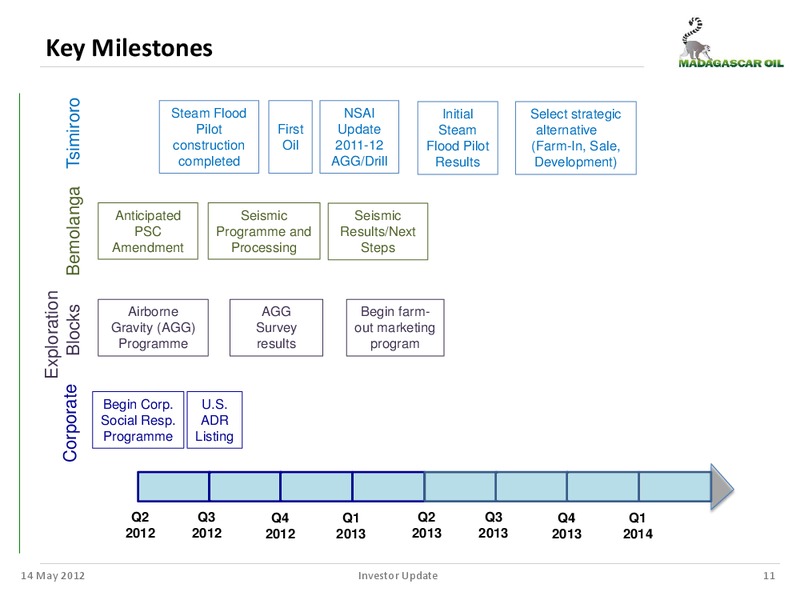

Key Milestones Bemolanga Tsimiroro Steam Flood NSAI Initial Select strategic Pilot First Update Steam alternative construction Oil 2011-12 Flood Pilot (Farm-In, Sale, completed AGG/Drill Results Development) Anticipated Seismic…
Tsimiroro Heavy Oil Project 14 May 2012 Investor Update 12

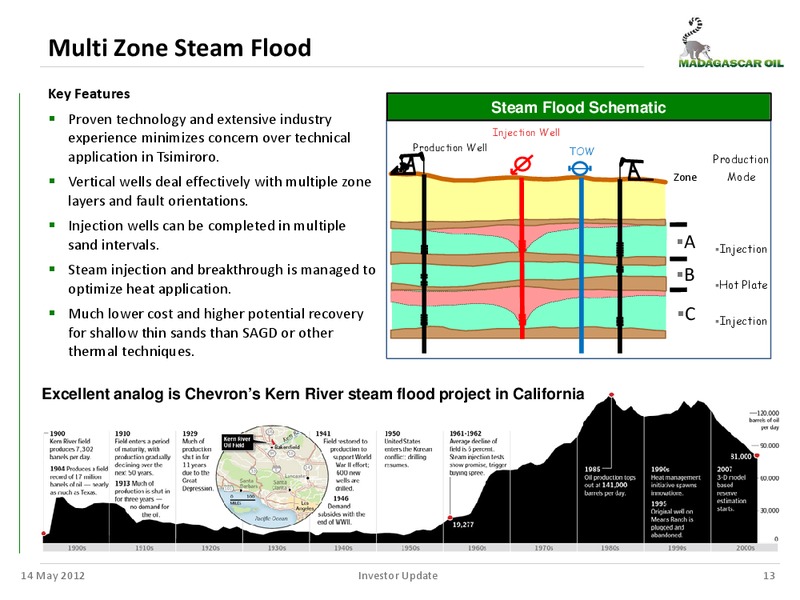

Multi Zone Steam Flood Key Features Steam Flood Schematic Proven technology and extensive industry Injection Well experience minimizes concern over technical Production Well TOW application in Tsimiroro. Production Zone Mode…

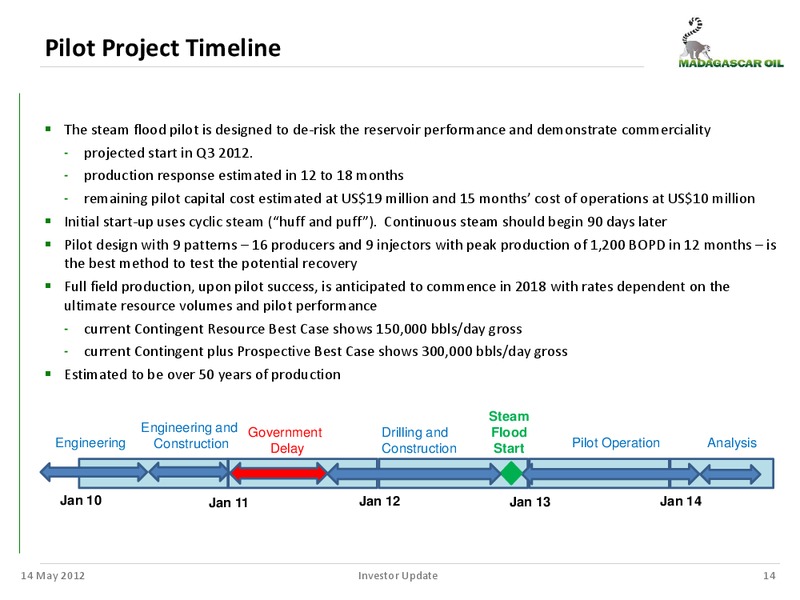

Pilot Project Timeline The steam flood pilot is designed to de-risk the reservoir performance and demonstrate commerciality - projected start in Q3 2012. - production response estimated in 12 to 18 months - remaining pilot capital…

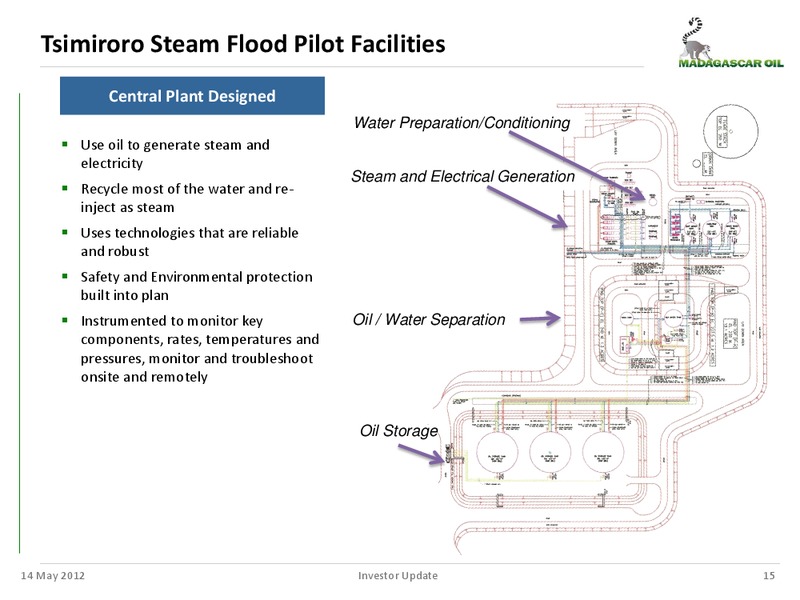

Tsimiroro Steam Flood Pilot Facilities Central Plant Designed Water Preparation/Conditioning Use oil to generate steam and electricity Steam and Electrical Generation Recycle most of the water and re- inject as steam Uses…

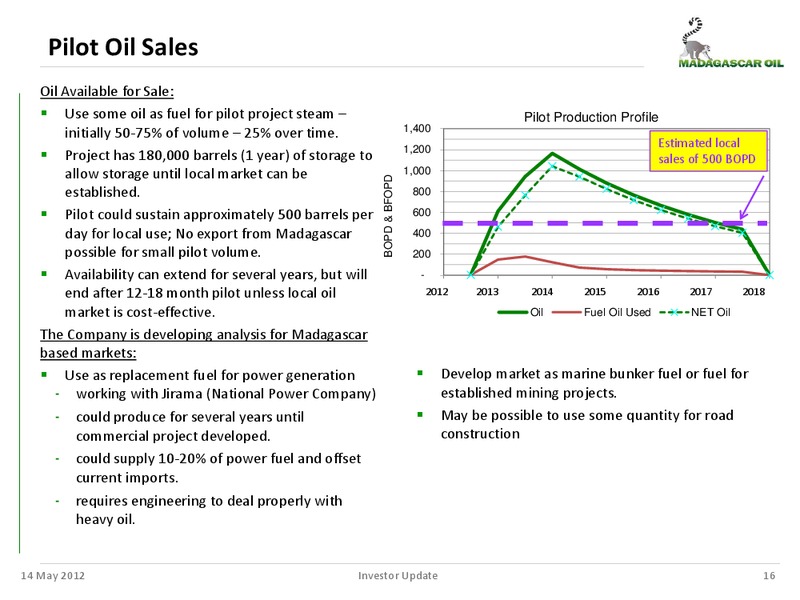

Pilot Oil Sales Oil Available for Sale: Use some oil as fuel for pilot project steam Pilot Production Profile initially 50-75% of volume 25% over time. 1,400 Estimated local Project has 180,000 barrels (1 year) of storage to 1,200…
Tsimiroro Economics 14 May 2012 Investor Update 17

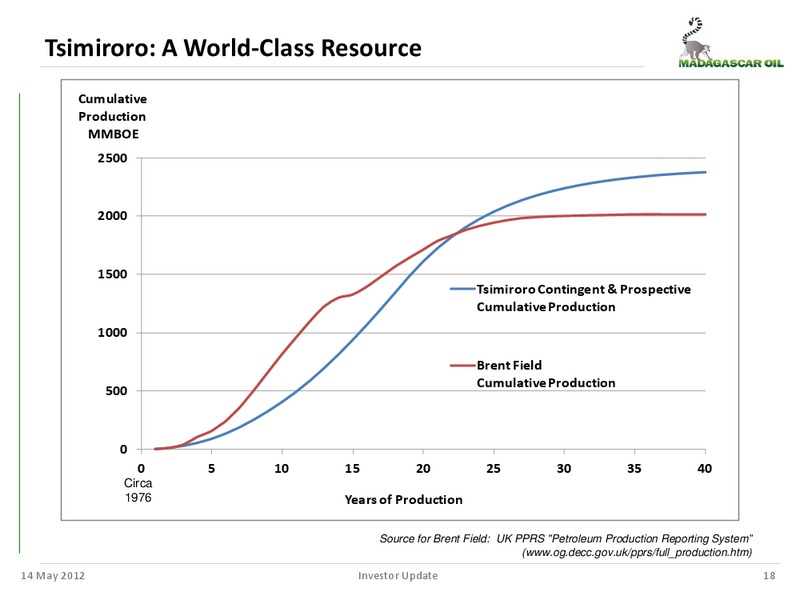

Tsimiroro: A World-Class Resource Cumulative Production MMBOE 2500 2000 1500 Tsimiroro Contingent & Prospective Cumulative Production 1000 Brent Field Cumulative Production 500 0 0 5 10 15 20 25 30 35 40 Circa 1976…

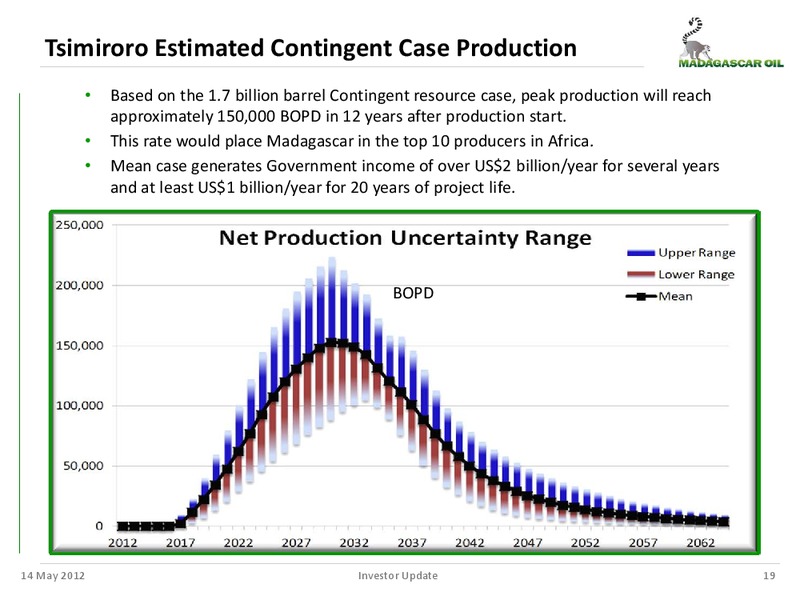

Tsimiroro Estimated Contingent Case Production Based on the 1.7 billion barrel Contingent resource case, peak production will reach approximately 150,000 BOPD in 12 years after production start. This rate would place Madagascar in the…

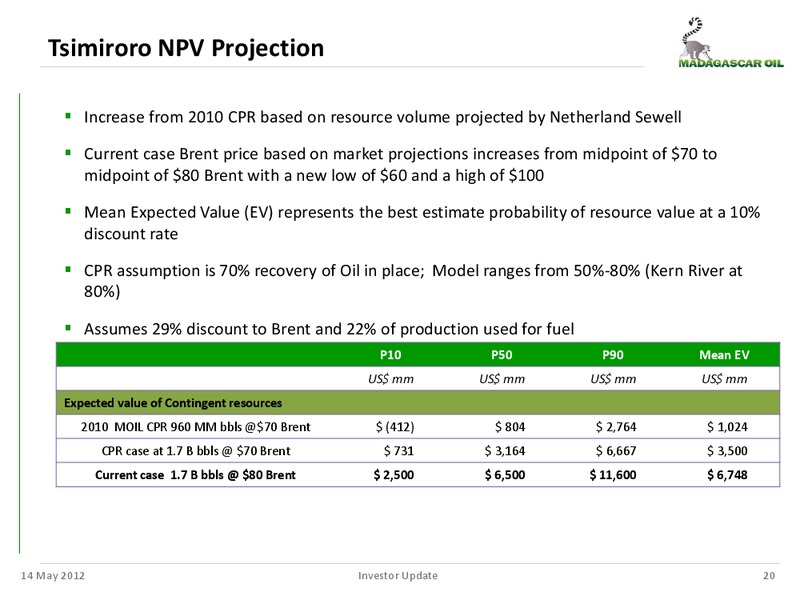

Tsimiroro NPV Projection Increase from 2010 CPR based on resource volume projected by Netherland Sewell Current case Brent price based on market projections increases from midpoint of 70 to midpoint of 80 Brent with a new low of 60…

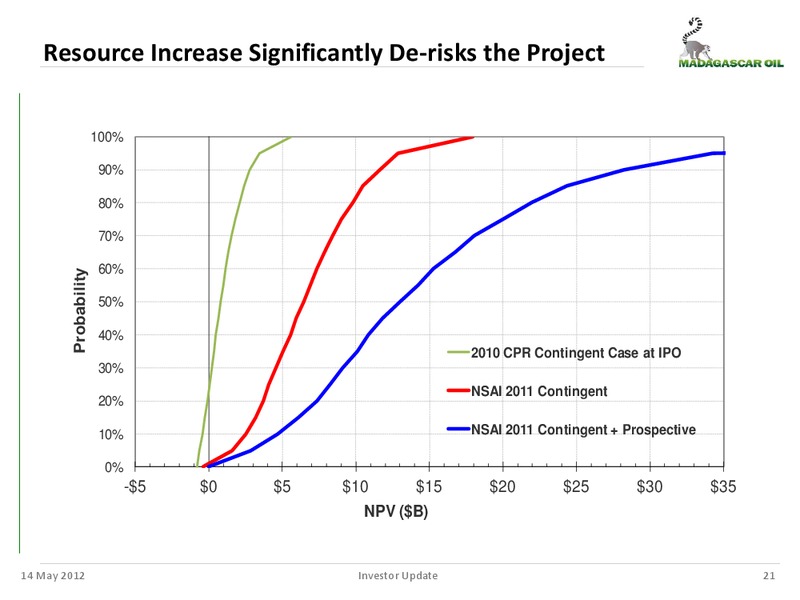

Resource Increase Significantly De-risks the Project 100% 90% 80% 70% 60% Probability 50% 40% 2010 CPR Contingent Case at IPO 30% NSAI 2011 Contingent 20% 10% NSAI 2011 Contingent + Prospective 0% -5 0 5 10 15…

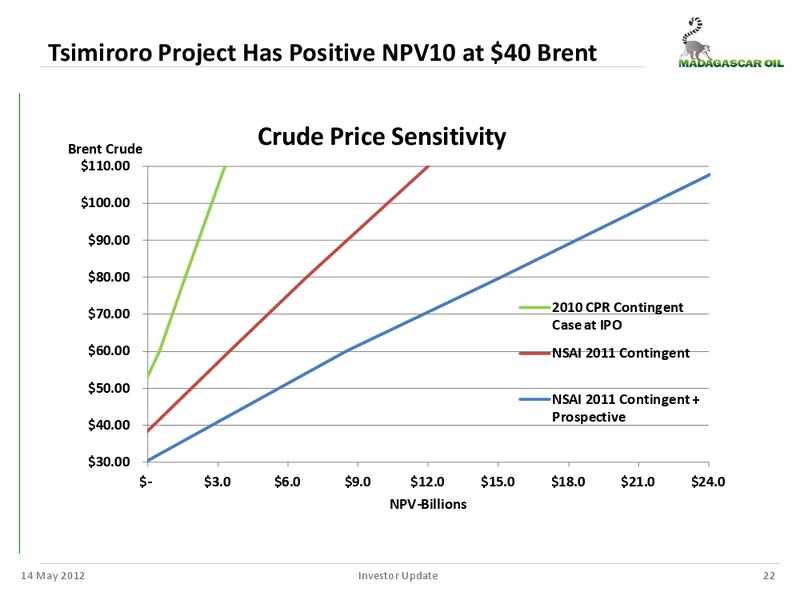

Tsimiroro Project Has Positive NPV10 at 40 Brent Brent Crude Crude Price Sensitivity 110.00 100.00 90.00 80.00 70.00 2010 CPR Contingent Case at IPO 60.00 NSAI 2011 Contingent 50.00 NSAI 2011 Contingent + Prospective…

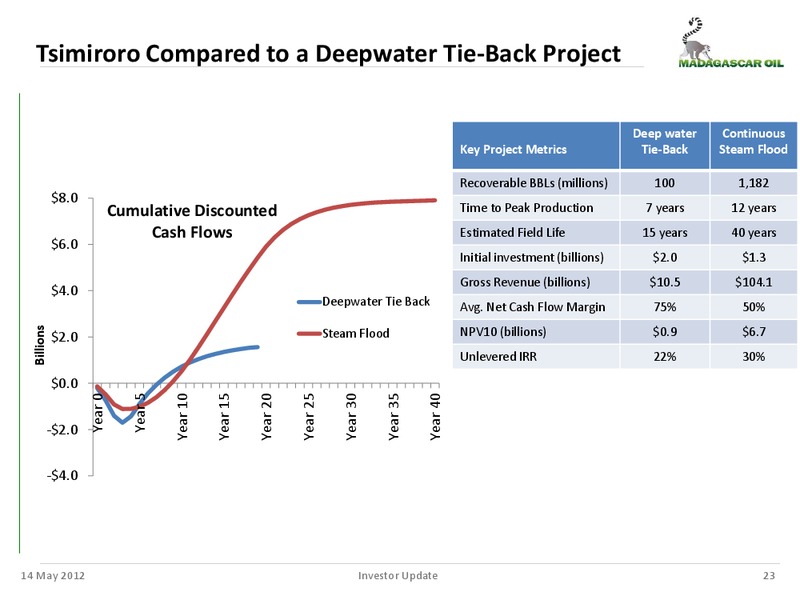

Tsimiroro Compared to a Deepwater Tie-Back Project Deep water Continuous Key Project Metrics Tie-Back Steam Flood Recoverable BBLs (millions) 100 1,182 8.0 Cumulative Discounted Time to Peak Production 7 years 12 years Cash Flows…
Conventional Opportunities 14 May 2012 Investor Update 24

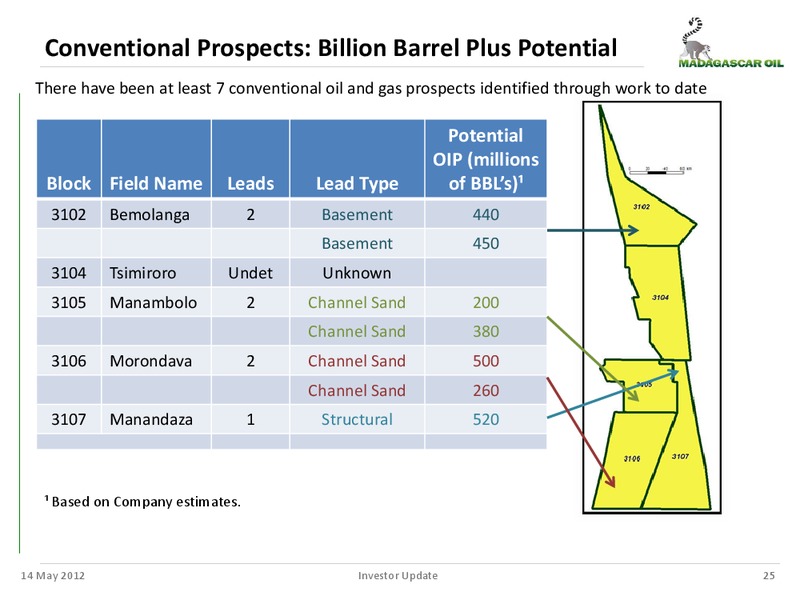

Conventional Prospects: Billion Barrel Plus Potential There have been at least 7 conventional oil and gas prospects identified through work to date Potential OIP (millions Block Field Name Leads Lead Type of BBLs) 3102 Bemolanga 2…

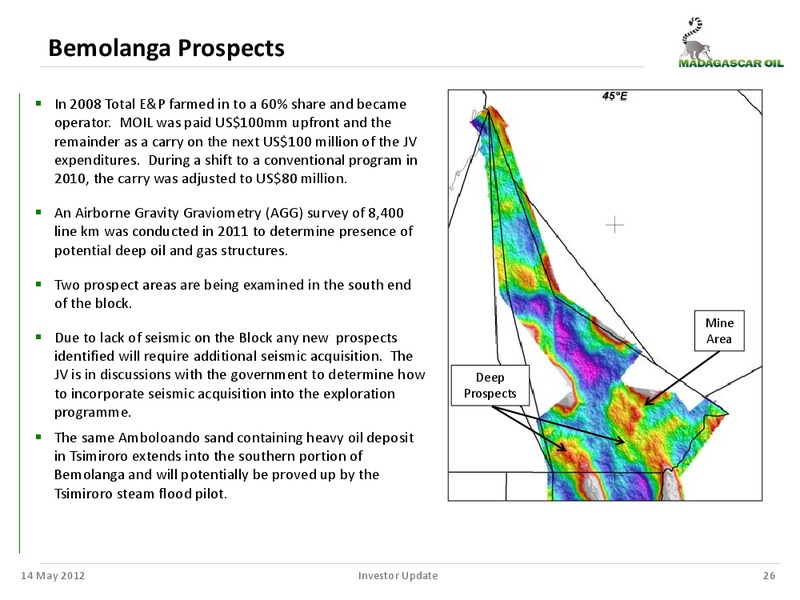

Bemolanga Prospects In 2008 Total E&P farmed in to a 60% share and became operator. MOIL was paid US100mm upfront and the remainder as a carry on the next US100 million of the JV expenditures. During a shift to a conventional program…

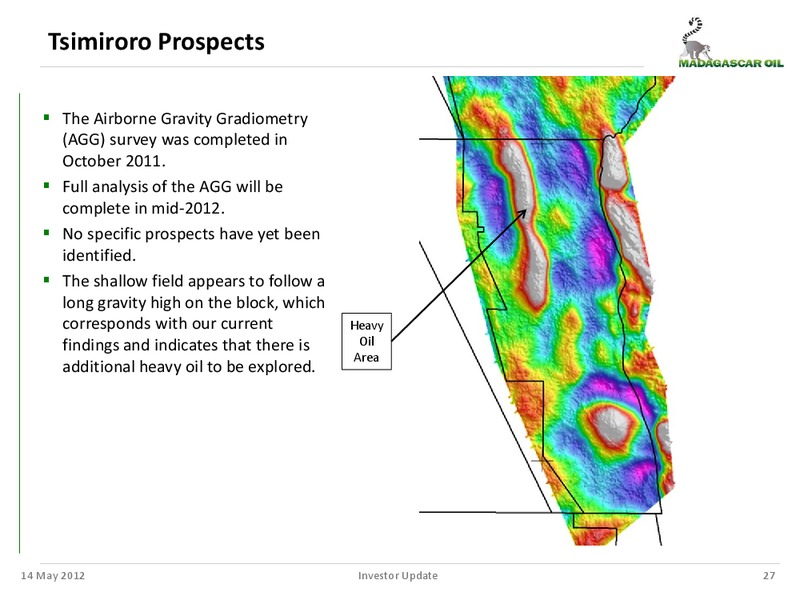

Tsimiroro Prospects The Airborne Gravity Gradiometry (AGG) survey was completed in October 2011. Full analysis of the AGG will be complete in mid-2012. No specific prospects have yet been identified. The shallow field appears to…

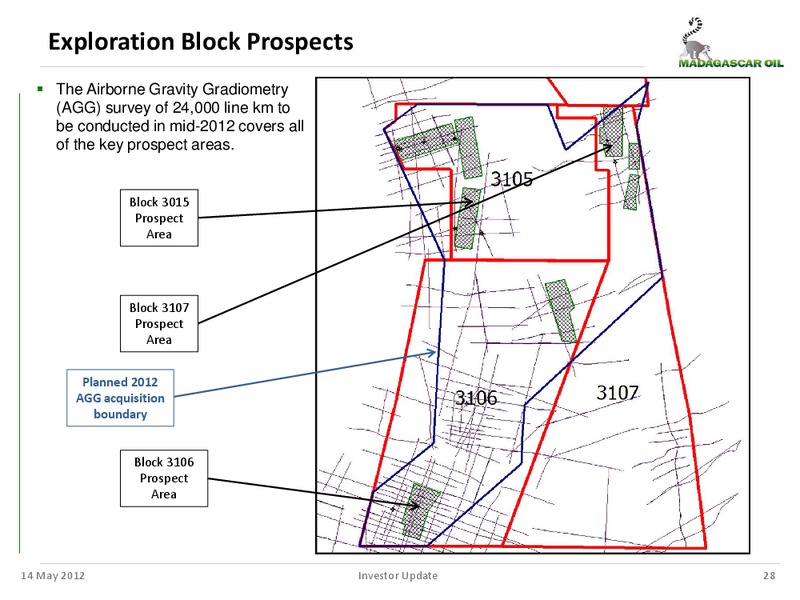

Exploration Block Prospects The Airborne Gravity Gradiometry (AGG) survey of 24,000 line km to be conducted in mid-2012 covers all of the key prospect areas. Block 3015 Prospect Area Block 3107 Prospect Area Planned…

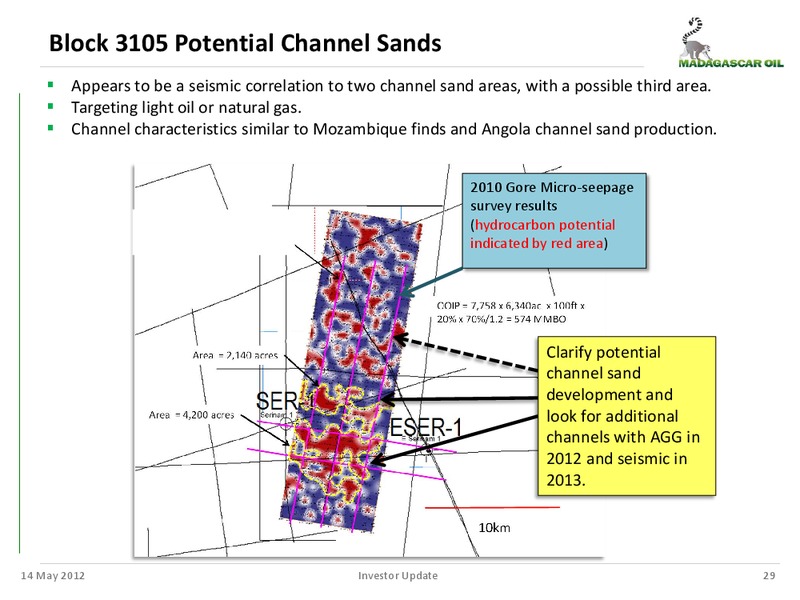

Block 3105 Potential Channel Sands Appears to be a seismic correlation to two channel sand areas, with a possible third area. Targeting light oil or natural gas. Channel characteristics similar to Mozambique finds and Angola channel…

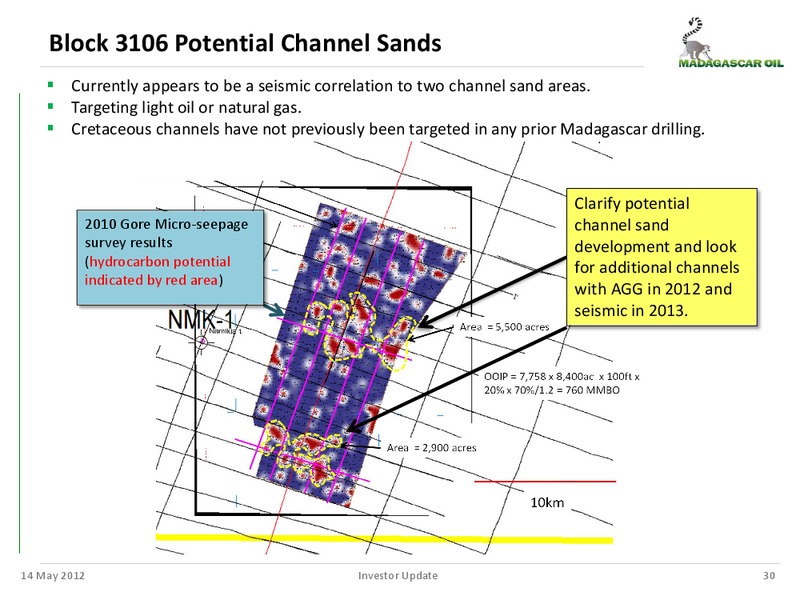

Block 3106 Potential Channel Sands Currently appears to be a seismic correlation to two channel sand areas. Targeting light oil or natural gas. Cretaceous channels have not previously been targeted in any prior Madagascar…
Funding and Capitalization 14 May 2012 Investor Update 31

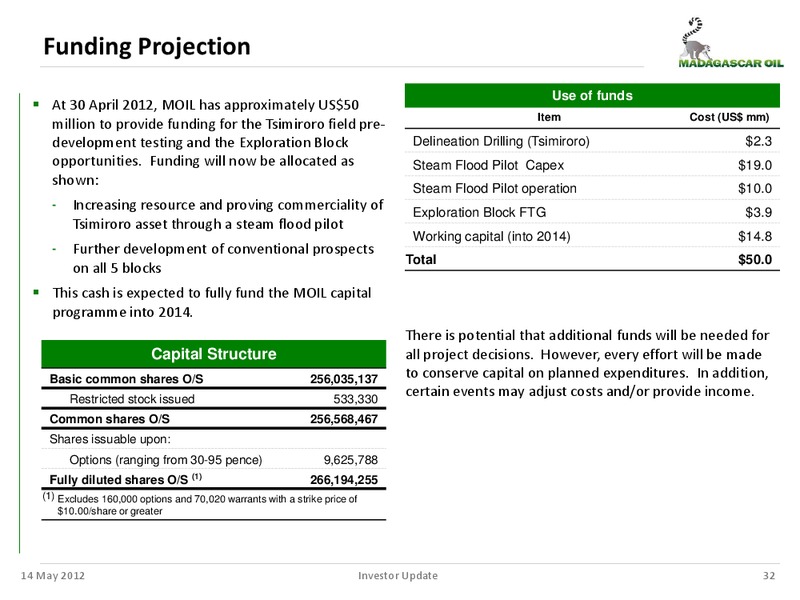

Funding Projection Use of funds At 30 April 2012, MOIL has approximately US50 Item Cost (US mm) million to provide funding for the Tsimiroro field pre- development testing and the Exploration Block Delineation Drilling (Tsimiroro)…
Appendix 14 May 2012 Investor Update 33

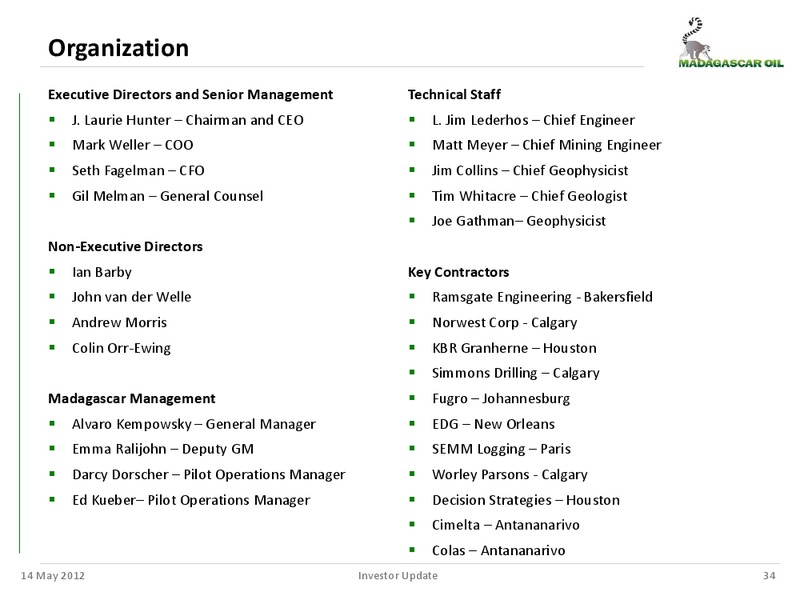

Organization Executive Directors and Senior Management Technical Staff J. Laurie Hunter Chairman and CEO L. Jim Lederhos Chief Engineer Mark Weller COO Matt Meyer Chief Mining Engineer Seth Fagelman CFO Jim Collins Chief…

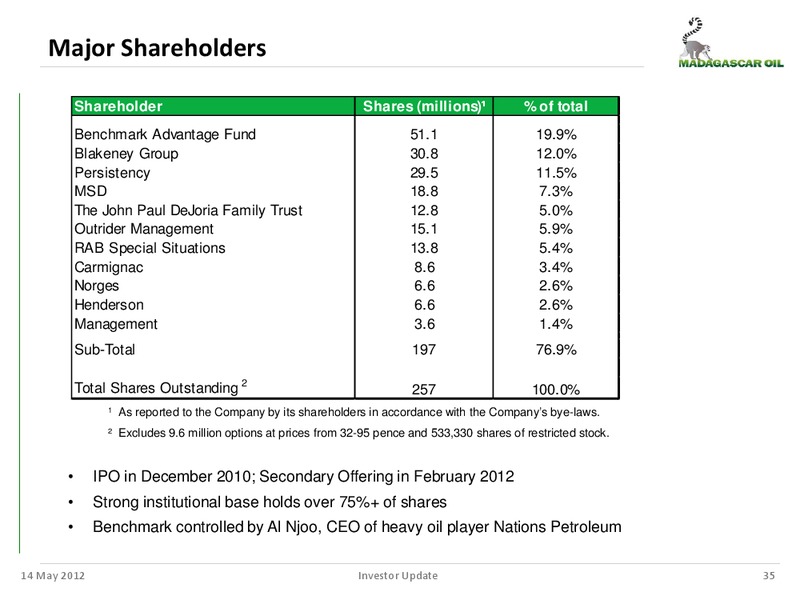

Major Shareholders Shareholder Shares (millions) % of total Benchmark Advantage Fund 51.1 19.9% Blakeney Group 30.8 12.0% Persistency 29.5 11.5% MSD 18.8 7.3% The John Paul DeJoria Family Trust 12.8 5.0% Outrider Management 15.1…

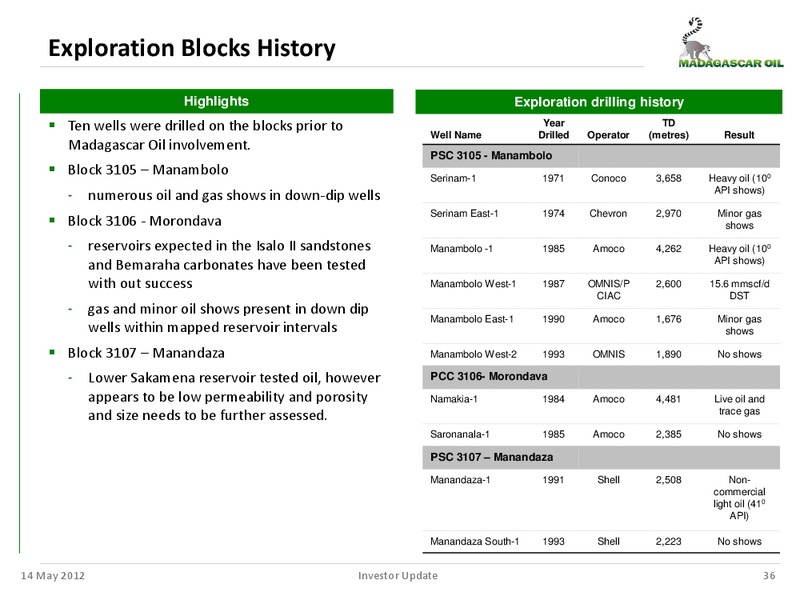

Exploration Blocks History Highlights Exploration drilling history Ten wells were drilled on the blocks prior to Well Name Year Drilled Operator TD (metres) Result Madagascar Oil involvement. PSC 3105 - Manambolo Block 3105…
