2013 production outlook Quarterly milestones Q1 Q1 milestones delivered Brazil FPSO 2 onstream Everest East expansion onstream First 2 of 7 2013 projects onstream Elgin/Franklin production restart Elgin/Franklin restarted Q2…
QCLNG update QCLNG terminal, Curtis Island Australia

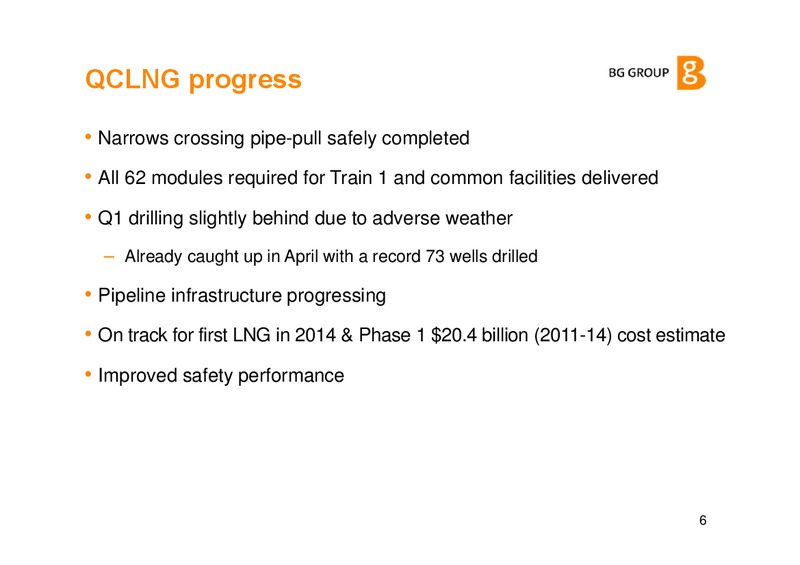

QCLNG progress Narrows crossing pipe-pull safely completed All 62 modules required for Train 1 and common facilities delivered Q1 drilling slightly behind due to adverse weather Already caught up in April with a record 73 wells…
QCLNG on-track for 2014 LNG sales 2013 2014 Q1 Q2 Q3 Q4 H1 H2 Wells: 1290 1450 1600 1750 2000 wells Q1: 1286 Upstream First major water facility (Kenya) Central processing plant (Ruby) Six Field Compressor Stations (for…
Brazil update Brazil update FPSO 2 Cidade de So FPSO 2 & Paulo 3, nowdeparture on location Brazil Santos Basin, Brazil
Brazil progress Start-up on Sapinho field on schedule and budget FPSO 2 producing ca 25 000 boed FPSO 1 and 2 production ca 140 000 boed during April FPSO 3 on Lula: on schedule for Q2 start up FPSOs 4 and 5 around 60% complete,…
Tanzania progress Block 4 Seven discoveries: 10 tcf gross Chewa resources Pweza Recent DSTs better than expected Papa Jodari - excellent Tertiary reservoir Block 3 Mzia - good Cretaceous reservoir Block 2 Zafarani Currently…

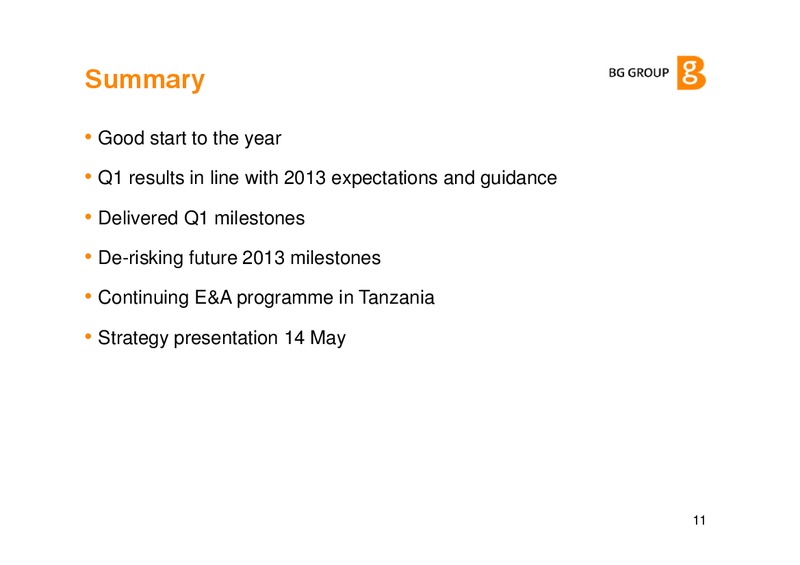

Summary Good start to the year Q1 results in line with 2013 expectations and guidance Delivered Q1 milestones De-risking future 2013 milestones Continuing E&A programme in Tanzania Strategy presentation 14 May 11
