    Industrial Commission Update Justin J. Kringstad Geological Engineer Director North Dakota Pipeline Authority June 20, 2019
  2. June 2019 Update – North Dakota Pipeline Authority – slide 2
    Statewide Initial Oil Production Rates 24hr JJ Kringstad - North Dakota Pipeline Authority 2 2
  3. June 2019 Update – North Dakota Pipeline Authority – slide 3
    Bakken/Three Forks Initial Production Rate: 24hr JJ Kringstad - North Dakota Pipeline Authority 3 3
  4. June 2019 Update – North Dakota Pipeline Authority – slide 4
    4,000+ BOPD 24hr Initial Production Rates JJ Kringstad - North Dakota Pipeline Authority 4 4
  5. June 2019 Update – North Dakota Pipeline Authority – slide 5
    Statewide Gas Performance 12% Improvement Over 2017 JJ Kringstad - North Dakota Pipeline Authority 5 Statewide Average BKN/TF Well Performance 5
  6. June 2019 Update – North Dakota Pipeline Authority – slide 6
    Statewide Initial Gas Production Rate: 24hr JJ Kringstad - North Dakota Pipeline Authority 6 6
  7. June 2019 Update – North Dakota Pipeline Authority – slide 7
    Bakken and Three Forks Gas Performance JJ Kringstad - North Dakota Pipeline Authority 7
  8. June 2019 Update – North Dakota Pipeline Authority – slide 8
    Top 20 IP Rates (Oil) JJ Kringstad - North Dakota Pipeline Authority 8 8
  9. June 2019 Update – North Dakota Pipeline Authority – slide 9
    Top 20 IP Rates (Oil) JJ Kringstad - North Dakota Pipeline Authority 9 9
  10. June 2019 Update – North Dakota Pipeline Authority – slide 10
    Top 20 IP Rates (Oil) JJ Kringstad - North Dakota Pipeline Authority 10 10
  11. June 2019 Update – North Dakota Pipeline Authority – slide 11
    Top 20 IP Rates (Oil) JJ Kringstad - North Dakota Pipeline Authority 11 11
  12. June 2019 Update – North Dakota Pipeline Authority – slide 12
    Top 20 IP Rates (Oil) *Month 0 is a partial month with daily production calculated using Days on production. Months 1+ use calendar days to calculate daily rate. JJ Kringstad - North Dakota Pipeline Authority 12 12
  13. June 2019 Update – North Dakota Pipeline Authority – slide 13
    Top 20 IP Rates (Oil) Electrical Submersible Pump (ESP) Timeline JJ Kringstad - North Dakota Pipeline Authority 13 13
  14. June 2019 Update – North Dakota Pipeline Authority – slide 14
    Impact of ESP on Production Profiles Well: SIBYL USA 44-19TFH (Mountrail County) *Month 0 is a partial month with daily production calculated using Days on production. Months 1+ use calendar days to calculate daily rate. JJ…
  15. June 2019 Update – North Dakota Pipeline Authority – slide 15
    Impact of ESP on Production Profiles Additional Examples Well File: 32012 Well File: 33942 *Month 0 is a partial month with daily production calculated using Days on production. Months 1+ use calendar days to calculate daily…
  16. June 2019 Update – North Dakota Pipeline Authority – slide 16
    High Initial Production (IP) Scenarios Typical type curve used as a In this example, the entire comparison example for how production curve over time is high IP wells may perform uplifted relative to a typical over time. well. Well…
  17. June 2019 Update – North Dakota Pipeline Authority – slide 17
    Oil IP Bin Comparison *Month 0 is a partial month with daily production calculated using Days on production. Months 1+ use calendar days to calculate daily rate. JJ Kringstad - North Dakota Pipeline Authority 17 17
  18. June 2019 Update – North Dakota Pipeline Authority – slide 18
    Oil IP Bin Comparison JJ Kringstad - North Dakota Pipeline Authority 18 18
  19. June 2019 Update – North Dakota Pipeline Authority – slide 19
    Oil IP Bin Comparison Clean JJ Kringstad - North Dakota Pipeline Authority 19 19
  20. June 2019 Update – North Dakota Pipeline Authority – slide 20
    Oil IP Bin Comparison Clean JJ Kringstad - North Dakota Pipeline Authority 20 20
  21. June 2019 Update – North Dakota Pipeline Authority – slide 21
    Economic Incentive to Higher IP Rates Example: Payout Period Using 7 million well cost JJ Kringstad - North Dakota Pipeline Authority 21 21
  22. June 2019 Update – North Dakota Pipeline Authority – slide 22
    Economic Incentive to Higher IP Rates Example: Rate of Return Using 7 million well cost JJ Kringstad - North Dakota Pipeline Authority 22 22
  23. June 2019 Update – North Dakota Pipeline Authority – slide 23
    Economic Incentive to Higher IP Rates Example: Breakeven Pricing Using 7 million well cost JJ Kringstad - North Dakota Pipeline Authority 23 23
  24. June 2019 Update – North Dakota Pipeline Authority – slide 24
    Crude Oil Prices June 20, 2019 Brent 64.23 Cushing WTI + 7.49 56.74 Pricing Data: Bloomberg & Houston WTI CME (LLS-Argus) WTI + 6.81 JJ Kringstad - North Dakota JJ Kringstad Pipeline - North Authority Dakota Pipeline…
  25. June 2019 Update – North Dakota Pipeline Authority – slide 25
    North Dakota Oil Pricing JJ Kringstad - North Dakota Pipeline Authority 25 25
  26. June 2019 Update – North Dakota Pipeline Authority – slide 26
    US Crude Oil Storage Volumes and Spot Prices JJ Kringstad - North Dakota Pipeline- Authority JJ Kringstad North Dakota Pipeline Authority 26 26 26
  27. June 2019 Update – North Dakota Pipeline Authority – slide 27

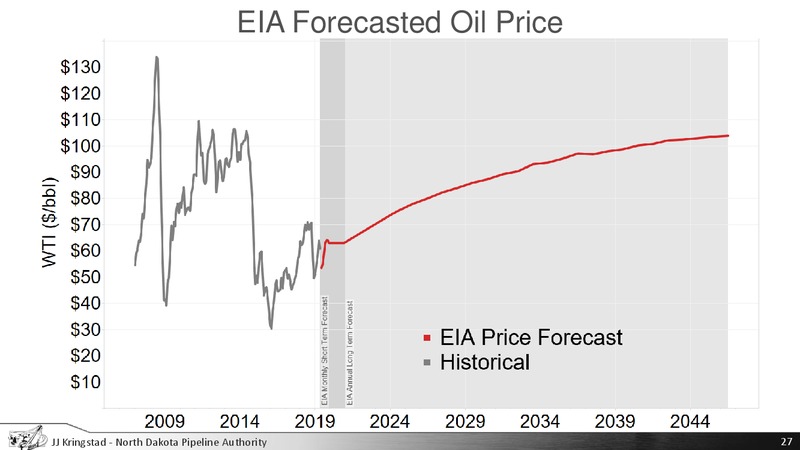

    EIA Forecasted Oil Price JJ Kringstad - North Dakota Pipeline Authority 27 27
  28. June 2019 Update – North Dakota Pipeline Authority – slide 28
    North Dakota Oil Production Forecast Assumes Current Technology Enhanced Oil Recovery Not Included JJ Kringstad - North Dakota Pipeline Authority 28 28
  29. June 2019 Update – North Dakota Pipeline Authority – slide 29
    Major Oil Transmission Systems JJ Kringstad - North Dakota Pipeline Authority 29 29
  30. June 2019 Update – North Dakota Pipeline Authority – slide 30
  31. June 2019 Update – North Dakota Pipeline Authority – slide 31

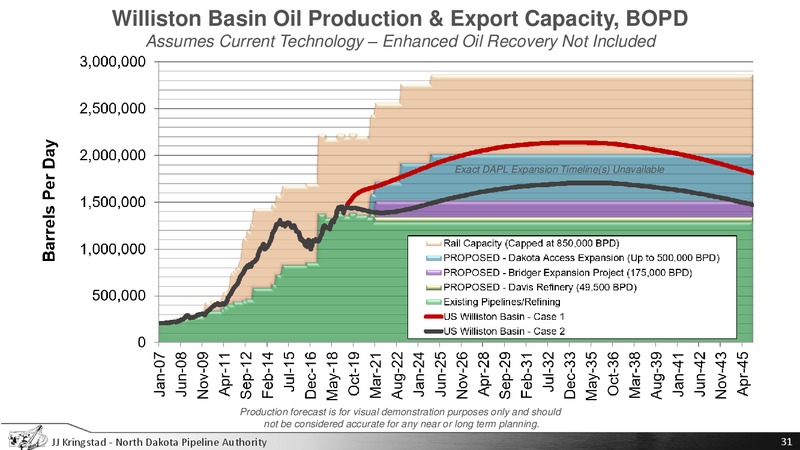

    Williston Basin Oil Production & Export Capacity, BOPD Assumes Current Technology Enhanced Oil Recovery Not Included Exact DAPL Expansion Timeline(s) Unavailable Production forecast is for visual demonstration purposes only…
  32. June 2019 Update – North Dakota Pipeline Authority – slide 32

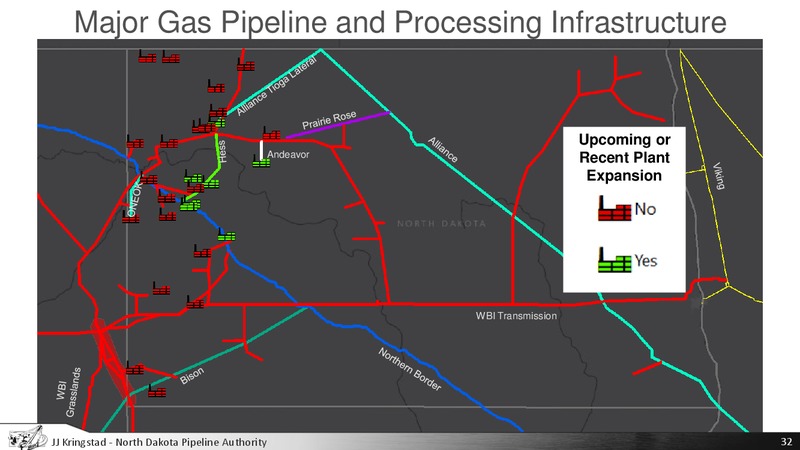

    Major Gas Pipeline and Processing Infrastructure Upcoming or Andeavor Recent Plant Expansion WBI Transmission JJ Kringstad - North Dakota JJ Kringstad Pipeline - North Authority Dakota Pipeline Authority 32 32
  33. June 2019 Update – North Dakota Pipeline Authority – slide 33
    WBI Energy North Bakken Expansion Project Project Highlights 67 Miles - 20 Pipeline 19 Miles - 12 Pipeline 220+ Million 250,000 MCFD Capacity (expandable) Expandable to 375,000 MCFD End of 2021 Proposed Completion Residue Gas…
  34. June 2019 Update – North Dakota Pipeline Authority – slide 34
    WBI Energy North Bakken Expansion Project Project Highlights 67 Miles - 20 Pipeline 19 Miles - 12 Pipeline 220+ Million 250,000 MCFD Capacity (expandable) Expandable to 375,000 MCFD End of 2021 Proposed Completion Residue Gas…
  35. June 2019 Update – North Dakota Pipeline Authority – slide 35

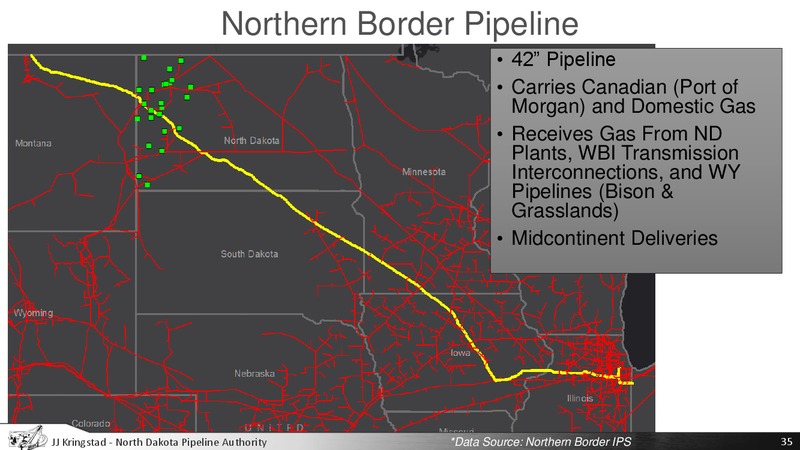

    Northern Border Pipeline 42 Pipeline Carries Canadian (Port of Morgan) and Domestic Gas Receives Gas From ND Plants, WBI Transmission Interconnections, and WY Pipelines (Bison & Grasslands) Midcontinent Deliveries JJ…
  36. June 2019 Update – North Dakota Pipeline Authority – slide 36
    Simplified Example NB Calculations Conclusion: IF no other gas export options open and all other deliveries on other pipelines stay static, ND gas production could increase 0.82-1.12 BCFD (from April-19) before Northern Border is 100%…
  37. June 2019 Update – North Dakota Pipeline Authority – slide 37
    Northern Border Proposed Expansion Options Two Proposed Options: Stateline/Watford City to Ventura -580 Mdth Incremental (525 MMCFD) -Phase 1: Q3 2021 -Phase 2: Q4 2023 Stateline/Watford City to Cheyenne -430 Mdth Incremental…
  38. June 2019 Update – North Dakota Pipeline Authority – slide 38
    Simplified Example NB Calculations Conclusion: IF no other gas export options open and all other deliveries on other pipelines stay static, ND gas production could increase 0.82-1.12 BCFD (from April-19) before Northern Border is 100%…
  39. June 2019 Update – North Dakota Pipeline Authority – slide 39
    Bakken Natural Gas Infrastructure 39 JJ Kringstad - North Dakota Pipeline Authority 39 39
  40. June 2019 Update – North Dakota Pipeline Authority – slide 40
    Regional NGL Infrastructure Kinder JJ Kringstad - North Dakota Pipeline Authority 40
  41. June 2019 Update – North Dakota Pipeline Authority – slide 41

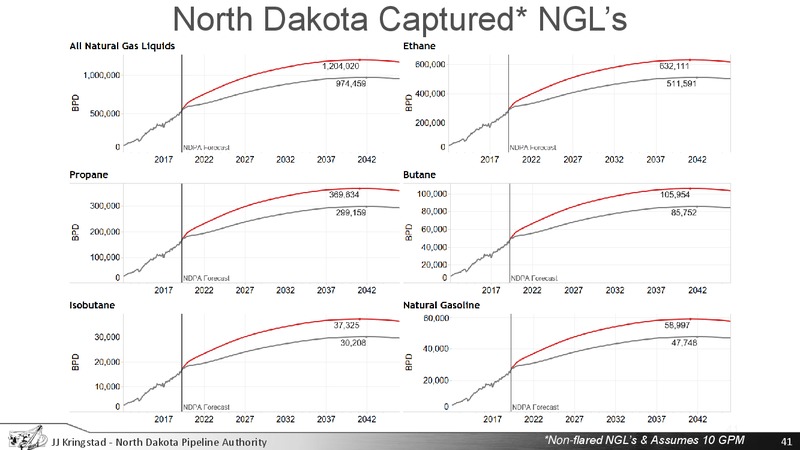

    North Dakota Captured* NGLs 41 JJ Kringstad - North Dakota Pipeline Authority *Non-flared NGLs & Assumes 41 10 GPM 41
  42. June 2019 Update – North Dakota Pipeline Authority – slide 42
    NGL Pipeline Takeaway Options 42 JJ Kringstad - North Dakota Pipeline Authority 42 42
  43. June 2019 Update – North Dakota Pipeline Authority – slide 43
    ONEOK Elk Creek NGL Pipeline Project Highlights 900 Miles - 20 Pipeline 1.4 Billion 240,000 BPD Capacity Expandable to 400,000 BPD End of 2019 Proposed Completion Y-Grade Transportation JJ Kringstad - North Dakota…
  44. June 2019 Update – North Dakota Pipeline Authority – slide 44
    Contact Information Justin J. Kringstad, Director North Dakota Pipeline Authority 600 E. Boulevard Ave. Dept. 405 Bismarck, ND 58505-0840 Phone: (701)220-6227 Fax: (701)328-2820 E-mail: jjkringstadndpipelines.com Websites:…
