Investor Day – Bankers Petroleum Ltd.

Bankers Petroleum Ltd. · Jun 1, 2014 · 75 slides

Investor presentation from the Shale Experts oil & gas presentation and slide database. Every page is imaged and its text indexed for search across operators, plays, basins and time.

Slides

  1. Investor Day – Bankers Petroleum Ltd. – slide 1
    June 2014 Investor Day TSX AIM: BNK
  2. Investor Day – Bankers Petroleum Ltd. – slide 2

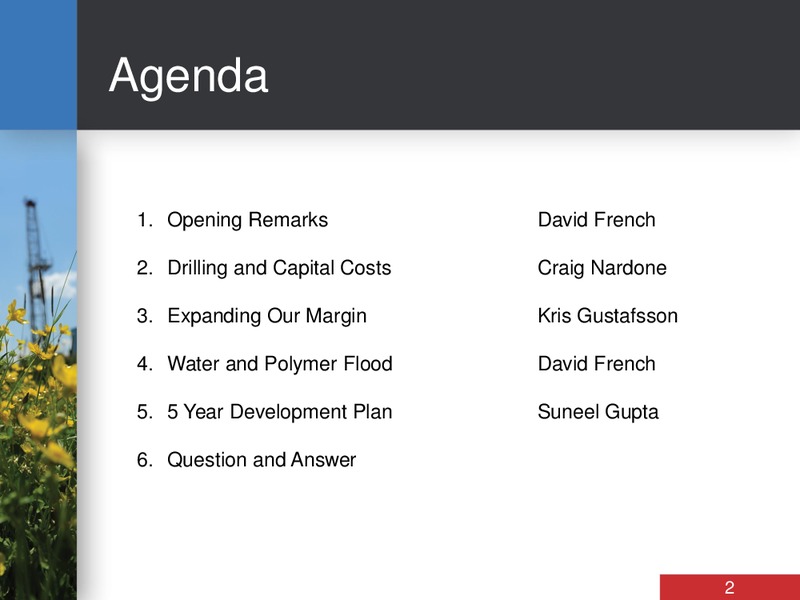

    Agenda 1. Opening Remarks David French 2. Drilling and Capital Costs Craig Nardone 3. Expanding Our Margin Kris Gustafsson 4. Water and Polymer Flood David French 5. 5 Year Development Plan Suneel Gupta 6. Question and…
  3. Investor Day – Bankers Petroleum Ltd. – slide 3
    Drilling Capital Costs Craig Nardone, VP Exploration and Development 3
  4. Investor Day – Bankers Petroleum Ltd. – slide 4
    Drilling Progress Report Recent Future Past Improvements Initiatives Drilling Costs: Drilling Costs: Drilling Costs: Average horizontal Horizontal wells drilled Additional savings well drilled in 14+ in 12+ days due to from SCM of…
  5. Investor Day – Bankers Petroleum Ltd. – slide 5
    Horizontal Wells by Zone 6 6 5 5 Rig Count 2.5 3.5 4 2 1 1 0 160 140 135 6 120 114 33 Horizontal Wells 21 100 80 76 39 11 60 60 50 40 20 56 29 45 6 20 3 29 36 10 13 1 8 8 6 0 2008 2009 2010 2011…
  6. Investor Day – Bankers Petroleum Ltd. – slide 6
    Hz Well Construction Costs Drill, Complete and Equip 1,400,000 1,289,256 1,261,230 1,200,000 Rig 21% Other 30% 1,082,178 1,000,000 1,011,932 800,000 Directional 600,000 18% Complete & Equip. 400,000 9% Mud…
  7. Investor Day – Bankers Petroleum Ltd. – slide 7
    Drilling Cost Improvements Average Horizontal Well Drill Cost and Depth 2323 2376 1,600 2,400 Average Drilling Cost US M 2272 2256 Average total depth (md) 1,400 2,300 1,200 2,200 1,192.23 1,000 1,092.18 2,100 800 903.13…
  8. Investor Day – Bankers Petroleum Ltd. – slide 8
    Drilling Time Improvements Average Drill Curve Days 0 2 4 6 8 10 12 14 16 0 Surface Hole Manage Drilling Variability Range of depths, field areas and zones 500 Surface Question and review build angle, well Casing path, ICP,…
  9. Investor Day – Bankers Petroleum Ltd. – slide 9
    Well Design Completion Design: In 2012 conducted mechanical analysis and manufacturing quality control review of slotted liners Liner redesign improved metallurgy strength and decreased slotted open area Zero liner failures with the…
  10. Investor Day – Bankers Petroleum Ltd. – slide 10
    Future Initiatives Procurement: Future drilling costs savings based on Supply Chain management of drilling materials (casing, cement, mud, completion equipment) Completion: Liner slot size, sand control, designed for 100% greater…
  11. Investor Day – Bankers Petroleum Ltd. – slide 11
    Expanding Our Margin Kris Gustafsson, Technical Director 11
  12. Investor Day – Bankers Petroleum Ltd. – slide 12
    Netback Realized 88.70 80.45 86.96 85.66 87.39 Price Controllable 15.60 14.62 13.59 13.23 13.23 Costs 14.15 12.16 13.05 12.72 13.60 6.25 9.99 10.24 8.87 11.43 55.75 48.96 49.05 50.48 42.19 Q1 2013 Q2 2013 Q3…
  13. Investor Day – Bankers Petroleum Ltd. – slide 13
    Controllable Costs Operations Expenditure and Sales & Transport Breakdown 30.00 2014 Q1 25.00 In-Field 20.00 Trans. Net Diluent 14% 20% /bbl 15.00 Energy 12% Trans. & Terminal 10.00 Fees Well 14% Servicing 16%…
  14. Investor Day – Bankers Petroleum Ltd. – slide 14
    Cost Structure Improvements Cost Potential Category Q1 2013 Q1 2014 Savings On-going Initiatives Savings (2-3 years) Produce lighter oil 0.50 - Proactive tank turnarounds Diluent 7.12 3.59 3.53 Optimize workovers 1.00 Optimize…
  15. Investor Day – Bankers Petroleum Ltd. – slide 15

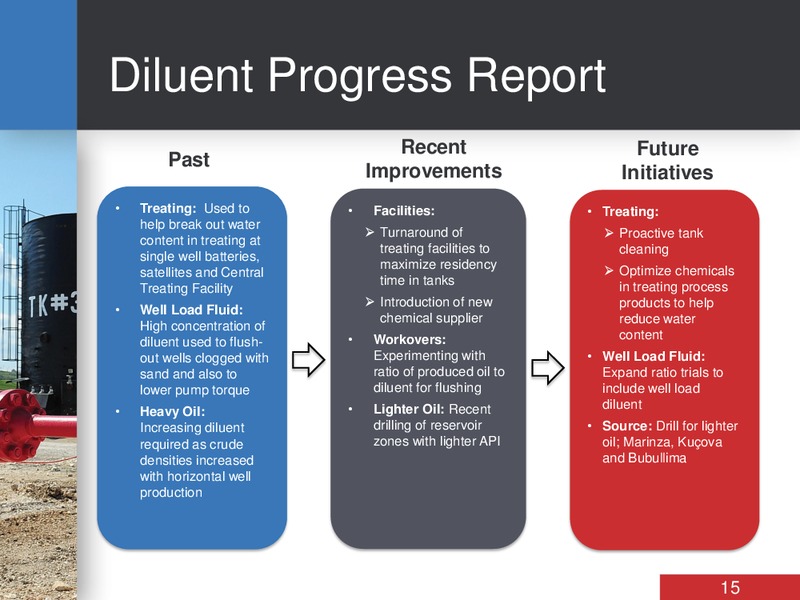

    Diluent Progress Report Recent Future Past Improvements Initiatives Treating: Used to Facilities: Treating: help break out water Turnaround of Proactive tank content in treating at treating facilities to cleaning single well…
  16. Investor Day – Bankers Petroleum Ltd. – slide 16
    Diluent Cost Look-back Change Chemical Supplier Facilities Turnaround 10.00 9.00 8.00 7.00 6.00 /bbl 5.00 4.00 3.00 2.00 1.00 - Q1 - 2012 Q2 - 2012 Q3 - 2012 Q4 - 2012 Q1 - 2013 Q2 - 2013 Q3 - 2013 Q4 -…
  17. Investor Day – Bankers Petroleum Ltd. – slide 17
    Oil Density by Zone 160 140 120 100 Horizontal Wells 80 D1 Marinza Heavier Oil Lighter Oil 60 40 20 0 2008 2009 2010 2011 2012 2013 2014 Q1 Bubullima Marinza L Driza U Driza Gorani 17
  18. Investor Day – Bankers Petroleum Ltd. – slide 18
    Diluent History Monthly Diluent Usage (% of Net Oil Production) 16.0 12.00 14.0 11.00 Raw Crude API Gravity 12.0 10.00 10.0 Diluent % 8.0 9.00 6.0 8.00 4.0 7.00 2.0 Lighter oil & operational improvements 0.0…
  19. Investor Day – Bankers Petroleum Ltd. – slide 19
    Energy Consumption Progress Report Past Recent Future Improvements Initiatives Simple Well Power: Pilot Well Power: Implement New Well All single well Power: Introduced natural batteries and wells on gas and electric Further expand…
  20. Investor Day – Bankers Petroleum Ltd. – slide 20

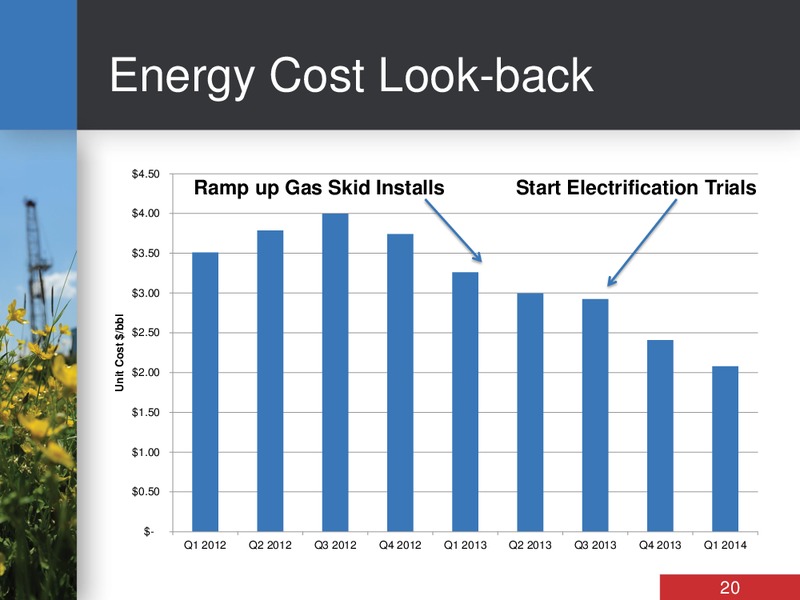

    Energy Cost Look-back 4.50 Ramp up Gas Skid Installs Start Electrification Trials 4.00 3.50 3.00 Unit Cost /bbl 2.50 2.00 1.50 1.00 0.50 - Q1 2012 Q2 2012 Q3 2012 Q4 2012 Q1 2013 Q2 2013 Q3 2013 Q4 2013 Q1…
  21. Investor Day – Bankers Petroleum Ltd. – slide 21
    Energy Source Cost Comparison Single Well Daily Operating Cost 250.00 200.00 150.00 100.00 50.00 - Diesel Propane Electricity Natural Gas Approximate values based on a type well making 113 bbls per day total fluid…
  22. Investor Day – Bankers Petroleum Ltd. – slide 22
    Electrification Trial Results 22
  23. Investor Day – Bankers Petroleum Ltd. – slide 23
    Diesel Consumption Pilot Results Pad L26A - 12 Well Diesel Consumption: Diesel vs. Electric Top Drive 2,500 Diesel 2,000 Electric (liters/day) 1,500 52% Reduction 1,000 500 0 Average Usage Further…
  24. Investor Day – Bankers Petroleum Ltd. – slide 24
    Propane/Natural Gas Power Units 180 Current Well Drive Energy Source 160 140 32% 61% Number of units installed 120 7% 100 80 Propane/Natural Gas Diesel Electric 60 40 20 0 24
  25. Investor Day – Bankers Petroleum Ltd. – slide 25
    Future Energy Strategy No longer purchasing diesel drives Electrify existing pads Temporarily use existing diesel skids on new drill locations Prepare existing pads to be fit with electric drives ahead of arrival in country 20,000…
  26. Investor Day – Bankers Petroleum Ltd. – slide 26
    Well Servicing Progress Report Recent Future Past Improvements Initiatives Pumps: One design Pumps: Low efficiency Pumps fits all pumps used pumps Innovate and throughout field Understanding improve PC pump Source of Failure:…
  27. Investor Day – Bankers Petroleum Ltd. – slide 27
    Well Servicing Unit Cost Look-Back Loose Pump Trials Ramping-up Rod Lift Programs Initiated 6.00 New Rod Fishing Tool Invented 5.00 4.00 /bbl 3.00 2.00 1.00 - Q1 - 2012 Q2 - 2012 Q3 - 2012 Q4 - 2012 Q1 - 2013…
  28. Investor Day – Bankers Petroleum Ltd. – slide 28

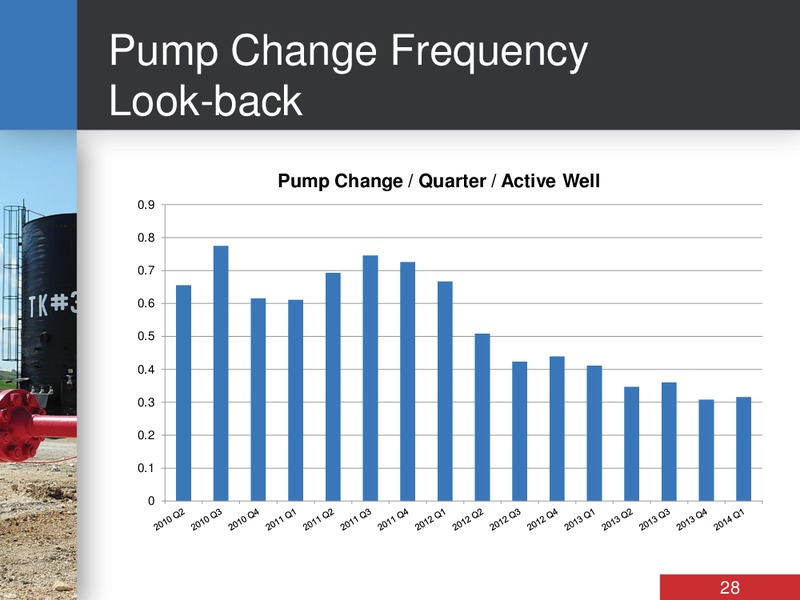

    Pump Change Frequency Look-back Pump Change / Quarter / Active Well 0.9 0.8 0.7 0.6 0.5 0.4 0.3 0.2 0.1 0 28
  29. Investor Day – Bankers Petroleum Ltd. – slide 29
    Tubing and Rod Failure Frequency Look-back Tubing Failures / Quarter / Active Well 0.35 0.30 0.25 0.20 0.15 0.10 0.05 0.00 Rod Failures / Quarter / Active Well 0.18 0.16 0.14 0.12 0.10 0.08 0.06 0.04 0.02 0.00 Opportunities…
  30. Investor Day – Bankers Petroleum Ltd. – slide 30
    Tracking Failure Mode and Run-times for PC Pumps Failures Stator Condition General wear Burnt Blisters 1% 4% 6% Rotor stuck Other 2% 19% Clean-out Scored 36% 20% Missing Pump rubber change 32% 18% Debonded 4% Hole-in-…
  31. Investor Day – Bankers Petroleum Ltd. – slide 31
    Well Servicing Strategies Continue efforts on researching optimal PC pump design for our tough downhole operating conditions, deeper than typical PC pump applications (multi-stage, thick elastomer) Customize pump design on a…
  32. Investor Day – Bankers Petroleum Ltd. – slide 32
    In-Field Transportation Progress Report Recent Future Past Improvements Initiatives Single Well Pad Site Connect Our Batteries: Optimization: Infrastructure: Required trucking of Portion of the field Significant oil, water, diesel…
  33. Investor Day – Bankers Petroleum Ltd. – slide 33
    In-Field Transportation Overview Production Trucked Into Facilities, 50,345 bopd (8,004 m3/d) Water Trucked to Disposal, 12,442 bopd (1,978 m3/d) 63,000 bpd (10,000 50.3% 12.4% m3/d) (63% of total transported volumes) are…
  34. Investor Day – Bankers Petroleum Ltd. – slide 34
    North-West Gathering System Estimated to be complete January 2015 Install proper gas gathering line Reduce existing trucking by: 6,300 bpd (1,000 m3/d) north of river 2,500 bpd (400 m3/d) south of river 14.0% of potential total…
  35. Investor Day – Bankers Petroleum Ltd. – slide 35
    North-East Gathering System Estimated to be complete January 2015 Install proper gas gathering line Reduce existing trucking by 12,250 bpd (1,950 m3/d) 19.5% of potential total trucked volumes to be flowlined 35
  36. Investor Day – Bankers Petroleum Ltd. – slide 36
    West Gathering System & Water Line Estimated to be complete December 2014 Install proper gas gathering line Install internally coated produced water line Reduce existing trucking by 7,850 bpd (1,250 m3/d) 12.5% of potential…
  37. Investor Day – Bankers Petroleum Ltd. – slide 37
    Future In-field Transportation Strategy Build Main Pipeline Corridor in Patos-Marinza Tie-in near-by existing wells with a focus on high volume areas and well pads closest to treating facilities Tie-in remote facilities based on…
  38. Investor Day – Bankers Petroleum Ltd. – slide 38
    Expanding our Margin - Q&A 38
  39. Investor Day – Bankers Petroleum Ltd. – slide 39
    Water and Polymer Flood David French, Chief Executive Officer 39
  40. Investor Day – Bankers Petroleum Ltd. – slide 40
    How it Works Water/Polymer Flooding: Very simple concept. Injecting water or polymer into the reservoir to displace oil Water flood: use produced or saline water (viscosity 1 cp) Polymer flood: adding a chemical (partially hydrolyzed…
  41. Investor Day – Bankers Petroleum Ltd. – slide 41

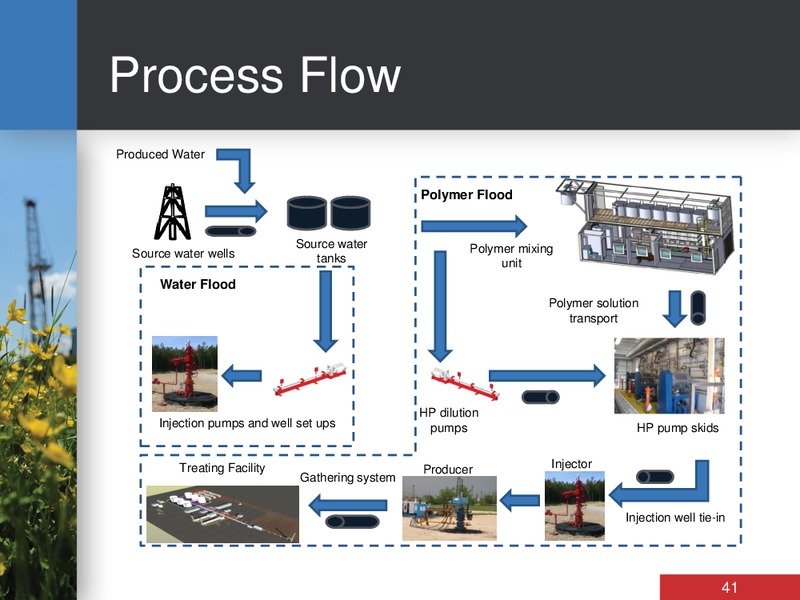

    Process Flow Produced Water Polymer Flood Source water Polymer mixing Source water wells tanks unit Water Flood Polymer solution transport HP dilution Injection pumps and well set ups pumps HP pump skids Treating…
  42. Investor Day – Bankers Petroleum Ltd. – slide 42

    Reservoir Flood Illustration Simulation demonstrates the water or polymer sweeping from the edge injectors toward the center producing well 42
  43. Investor Day – Bankers Petroleum Ltd. – slide 43
    Illustration Type Curve Early Stage 250 Oil rate plateau for 4-8 months Oil rate peak response (increasing water production Fully Supported Producer rate during period) 200 1 well converted at 12 months ( 50 bopd) Oil Rate…
  44. Investor Day – Bankers Petroleum Ltd. – slide 44
    Type Curve Evaluation 250 ILLUSTRATIVE 200 Oil Rate (bopd) 150 Economic Hurdle Rate for Peak Response 100 bopd 100 50 0 0 12 24 36 48 60 72 84 96 108 120 132 Time (Months) Primary Recovery +5% Recovery +12%…
  45. Investor Day – Bankers Petroleum Ltd. – slide 45
    Reservoir Description Patos-Marinza is a multi-layer unconsolidated sand reservoir Up to 300m gross & 200m net oil pay Driza Formation 50 m 7 reservoir zones Polymer flood pilot in Lower Driza sands D3, D4, D5 PF…
  46. Investor Day – Bankers Petroleum Ltd. – slide 46
    Check list Can we inject Injection of water/polymer at economic rates Ability to inject at sufficient rates Ability to maintain injection Avoidance of formation damage/plugging Reservoir pressure increase/stabilization Reservoir…
  47. Investor Day – Bankers Petroleum Ltd. – slide 47
    Water Flood Pilot Characteristics Current Water Flood Patterns: M0 Marinza Reservoir Zone 3 Injectors, 4 Offset Producers General: Pattern Type: Horizontal line drive Well Spacing: 100m Geology/Petrophysics: Net Pay: 6m…
  48. Investor Day – Bankers Petroleum Ltd. – slide 48
    Water Flood Results: M0 M0 - 5190 - Pattern 100 Oil Rate (bopd) 10 1 May-12 Oct-12 May-13 Oct-13 May-14 Oct-14 May-15 Oct-15 Actual Oil Rate +5% Recovery Producer Half Supported Primary Type Curve +12% Recovery…

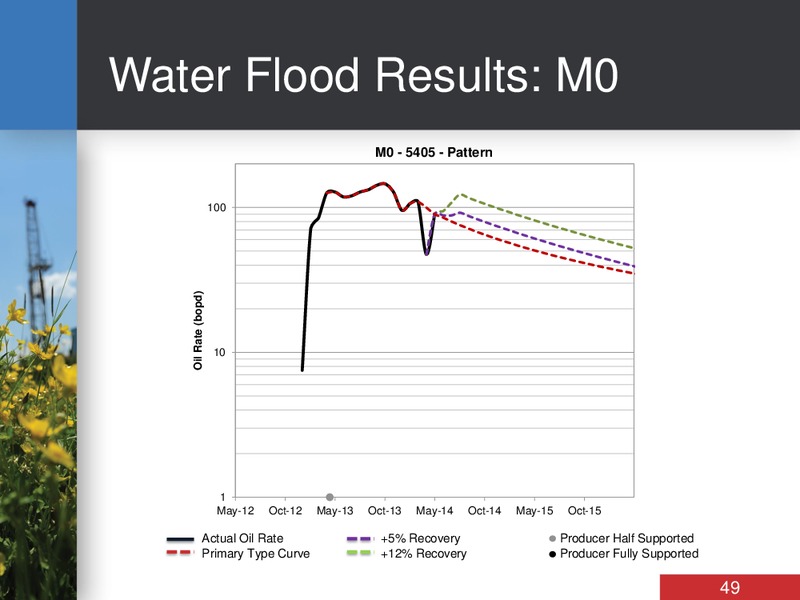

  49. Investor Day – Bankers Petroleum Ltd. – slide 49
    Water Flood Results: M0 M0 - 5405 - Pattern 100 Oil Rate (bopd) 10 1 May-12 Oct-12 May-13 Oct-13 May-14 Oct-14 May-15 Oct-15 Actual Oil Rate +5% Recovery Producer Half Supported Primary Type Curve +12% Recovery…
  50. Investor Day – Bankers Petroleum Ltd. – slide 50

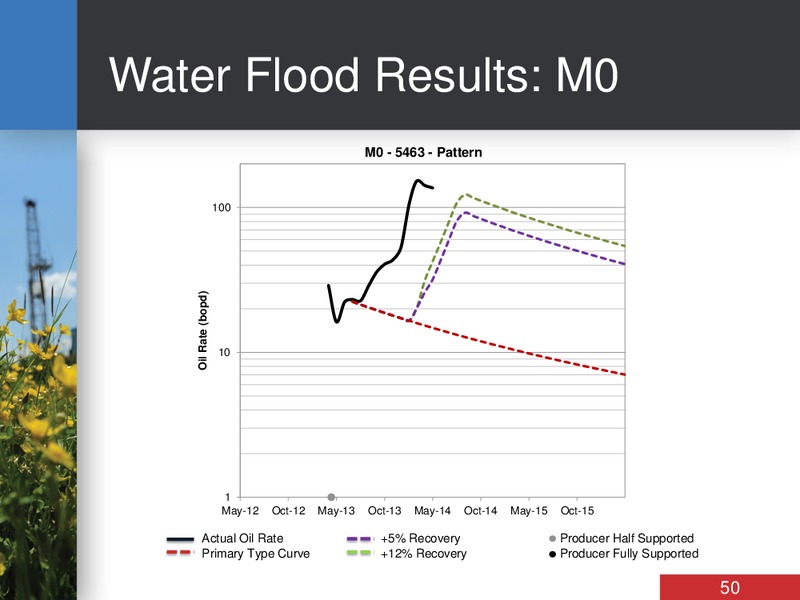

    Water Flood Results: M0 M0 - 5463 - Pattern Oil Rate (bopd) 100 10 1 May-12 Oct-12 May-13 Oct-13 May-14 Oct-14 May-15 Oct-15 Actual Oil Rate +5% Recovery Producer Half Supported Primary Type Curve +12% Recovery Producer…
  51. Investor Day – Bankers Petroleum Ltd. – slide 51
    Water Flood Results: M0 Oil Rate (bopd) M0 Pilot Results 100 10 May-12 Oct-12 May-13 Oct-13 May-14 Oct-14 May-15 Oct-15 Actual Oil Rate +5% Recovery Conversions Primary Type Curve +12% Recovery 51
  52. Investor Day – Bankers Petroleum Ltd. – slide 52
    Water Flood: Continuing to Monitor Can we inject Injection of water/polymer at economic rates Avoidance of formation damage/plugging Reservoir pressure increase/stabilization Reservoir pressure to increase at injectors then stabilize…
  53. Investor Day – Bankers Petroleum Ltd. – slide 53
    Polymer Flood Pilot Characteristics Current Polymer Flood Patterns: D5, D4, D3 Lower Driza Reservoir Zones 9 Injectors, 9 12 Offset Producers General: Pattern Type: Horizontal line drive Well Spacing: 100m Geology/Petrophysics:…
  54. Investor Day – Bankers Petroleum Ltd. – slide 54
    Polymer Flood Results: D5 D5 - 5433 - Pattern 100 Oil Rate (bopd) 10 1 Actual Oil Rate +5% Recovery Producer Half Supported Primary Type Curve +12% Recovery Producer Fully Supported 54
  55. Investor Day – Bankers Petroleum Ltd. – slide 55
    Polymer Flood Results: D5 D5 - 5272 - Pattern 100 Oil Rate (bopd) 10 1 May-12 Oct-12 May-13 Oct-13 May-14 Oct-14 May-15 Oct-15 Actual Oil Rate +5% Recovery Producer Half Supported Primary Type Curve +12% Recovery…
  56. Investor Day – Bankers Petroleum Ltd. – slide 56
    Polymer Flood Results: D5 D5 - 5424 - Pattern 100 Oil Rate (bopd) 10 1 May-12 Oct-12 May-13 Oct-13 May-14 Oct-14 May-15 Oct-15 Actual Oil Rate +5% Recovery Producer Half Supported Primary Type Curve +12% Recovery…
  57. Investor Day – Bankers Petroleum Ltd. – slide 57
    Polymer Flood Results: D5 D5 - Pilot Results 1000 Oil Rate (bopd) 100 10 May-12 Oct-12 May-13 Oct-13 May-14 Oct-14 May-15 Oct-15 Actual Oil Rate +5% Recovery Conversions Primary Type Curve +12% Recovery 57
  58. Investor Day – Bankers Petroleum Ltd. – slide 58

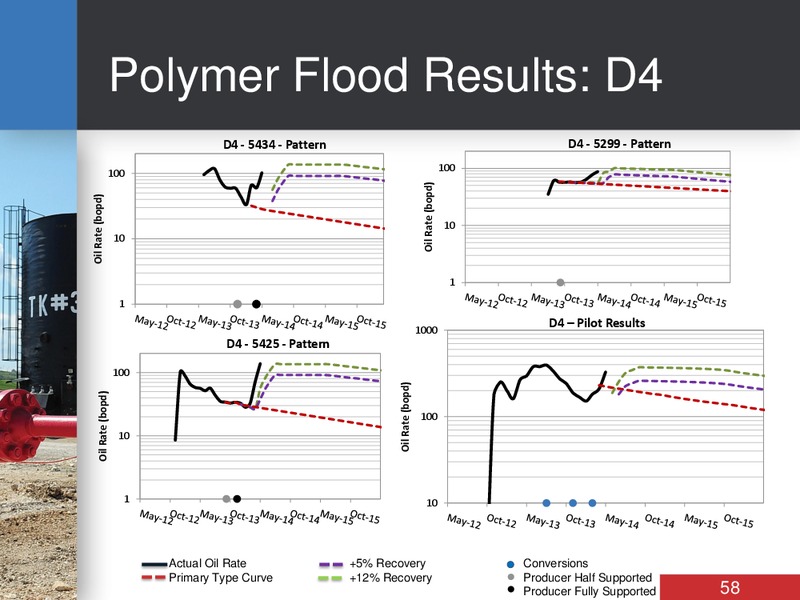

    Polymer Flood Results: D4 D4 - 5434 - Pattern D4 - 5299 - Pattern 100 100 Oil Rate (bopd) Oil Rate (bopd) 10 10 1 1 1000 D4 Pilot Results D4 - 5425 - Pattern 100 Oil Rate (bopd) Oil Rate (bopd) 100…
  59. Investor Day – Bankers Petroleum Ltd. – slide 59
    Polymer Flood Results: D3 D3 - 5426 - Pattern D3 5273 - Pattern 100 100.00 Oil Rate (bopd) Oil Rate (bopd) 10.00 10 1.00 1 D3 Pilot Results 1000 5435 - D3 - Pattern 100 Oil Rate (bopd) Oil Rate (bopd)…
  60. Investor Day – Bankers Petroleum Ltd. – slide 60

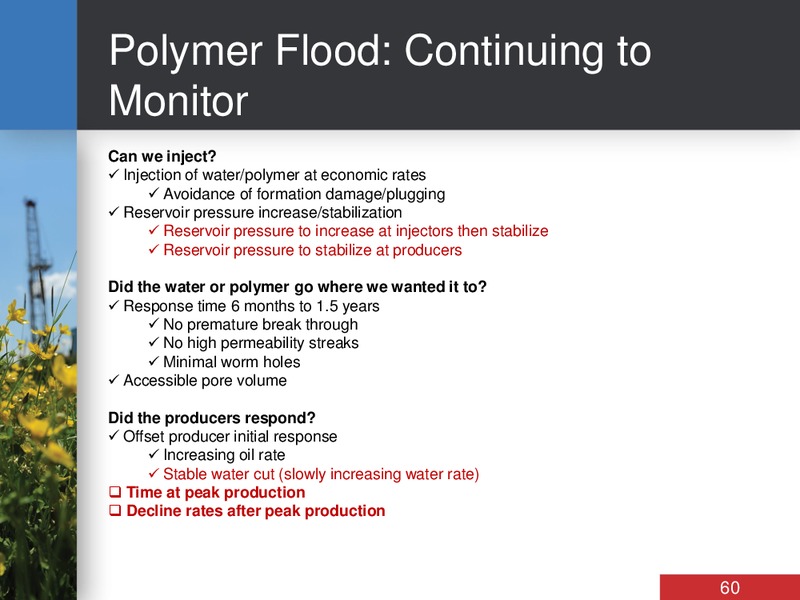

    Polymer Flood: Continuing to Monitor Can we inject Injection of water/polymer at economic rates Avoidance of formation damage/plugging Reservoir pressure increase/stabilization Reservoir pressure to increase at injectors then…
  61. Investor Day – Bankers Petroleum Ltd. – slide 61
    Water and Polymer Summary We are strongly encouraged by the results and will continue to expand the water and polymer flood pilots to test additional areas of the field and reservoir zones with 14 conversions in 2014 and 25…
  62. Investor Day – Bankers Petroleum Ltd. – slide 62
    Polymer and Water flood - Q&A 62
  63. Investor Day – Bankers Petroleum Ltd. – slide 63
    5 Year Development Plan Suneel Gupta, Chief Operating Officer 63
  64. Investor Day – Bankers Petroleum Ltd. – slide 64
    Primary Development Continue primary drilling of Patos-Marinza through horizontal wells Large drilling inventory of high quality locations across multiple reservoir zones Future locations of 1000+ wells with lateral well spacing…
  65. Investor Day – Bankers Petroleum Ltd. – slide 65
    Primary Production Forecast 45,000 40,000 Primary Development achieves 10 15% growth per year over the next few years 35,000 30,000 Oil Rate (bopd) 25,000 20,000 15,000 10,000 5,000 0 2014 2015 2016 2017 2018 2019…
  66. Investor Day – Bankers Petroleum Ltd. – slide 66
    EOR Development Strategy Initial Phase Selection (2013 2014): Focused on reservoir control and oil quality to evaluate injection rates, production response and facilities. Initial phase in South Lower Driza zones Second Phase…
  67. Investor Day – Bankers Petroleum Ltd. – slide 67
    Development Example D3U 67
  68. Investor Day – Bankers Petroleum Ltd. – slide 68
    Development Example D3U 68
  69. Investor Day – Bankers Petroleum Ltd. – slide 69

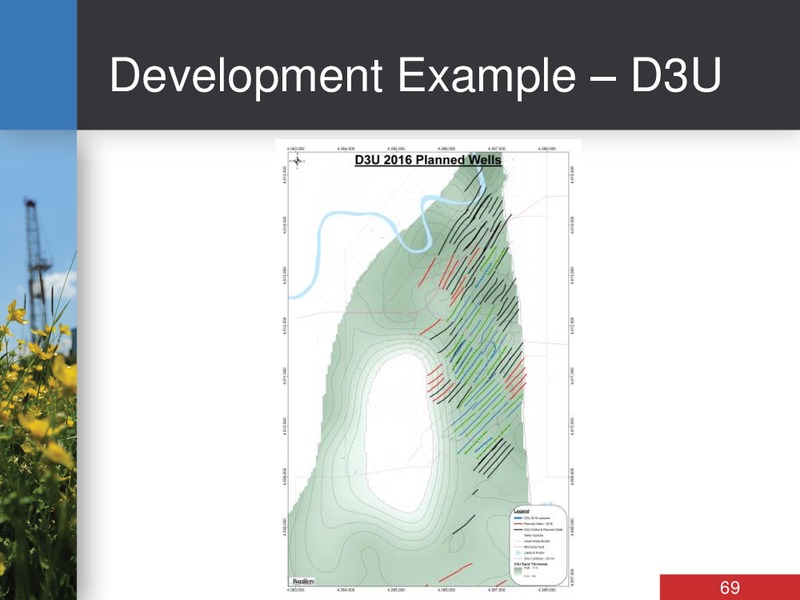

    Development Example D3U 69
  70. Investor Day – Bankers Petroleum Ltd. – slide 70
    Development Example D3U 70
  71. Investor Day – Bankers Petroleum Ltd. – slide 71
    Development Example D3U 71
  72. Investor Day – Bankers Petroleum Ltd. – slide 72
    Primary & Secondary Forecast 50,000 Primary & EOR improves 45,000 growth & reduces field decline 10-15% Growth 40,000 rates 35,000 Oil Rate (bopd) 30,000 25,000 20,000 15,000 10,000 5,000 0 2014 2015 2016 2017 2018 2019…
  73. Investor Day – Bankers Petroleum Ltd. – slide 73
    Prudent Pace of Development Continued focus on primary drilling with 6 rigs EOR conversions of 25 30 wells per year Prudent Pace of Development program is re-adjusted annually and semi- annually based on performance and…
  74. Investor Day – Bankers Petroleum Ltd. – slide 74
    Thermal 2000 m Focused on shallower areas of field < 1000m but depends on technology employed Focused on areas with low density of Albpetrol wells or where old wells can be properly suspended Data collection in 2014: Initial…
  75. Investor Day – Bankers Petroleum Ltd. – slide 75
    5-Year Development Plan 2014 2015 2016 2017 2018 The Opportunity Primary 10 15% Annual 150 170 Drilling 6 Drilling Production Horizontal 9.72/share, based on 2013 Program Rig Program 2P Reserves Case Growth Wells/Year Firm…
